Head office construction project

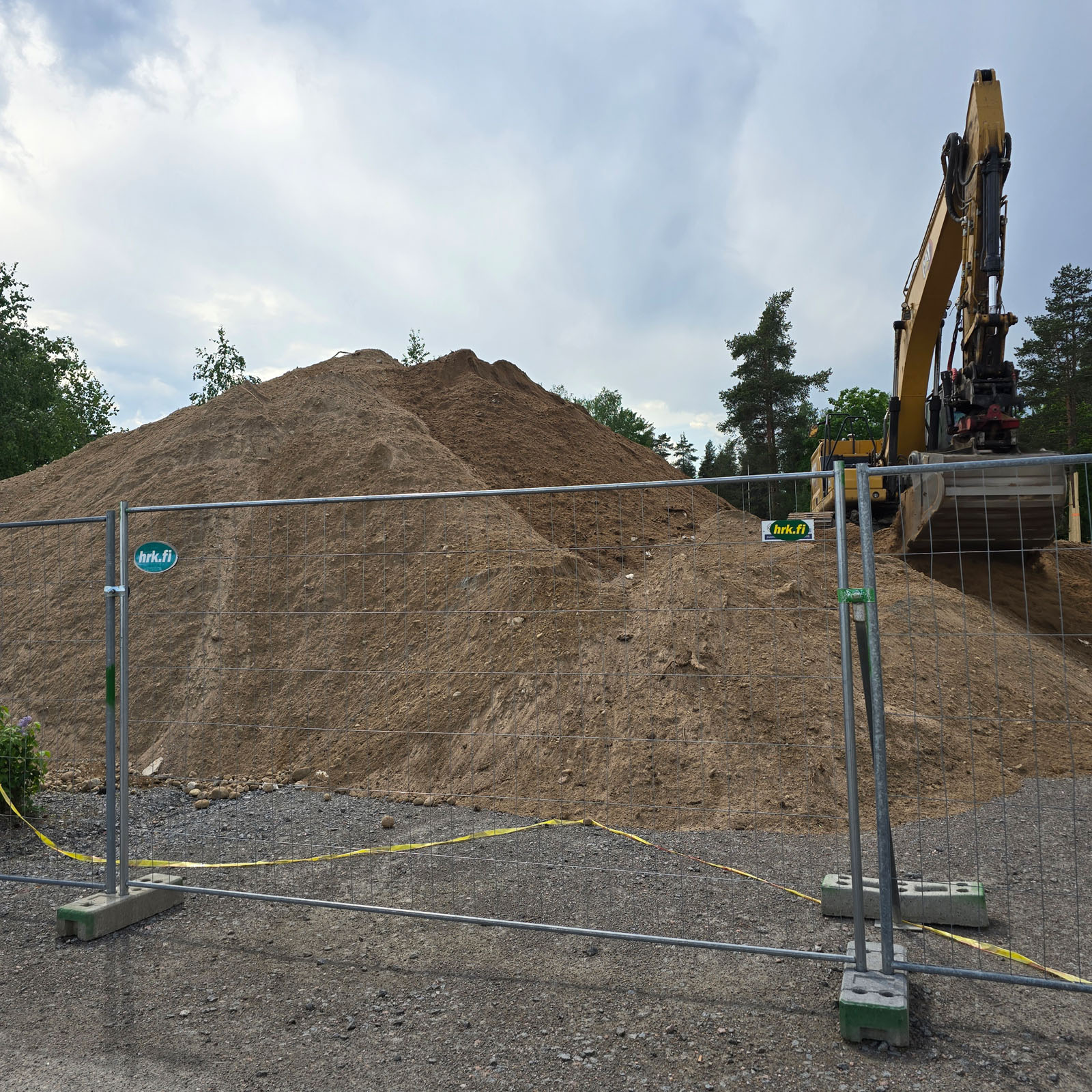

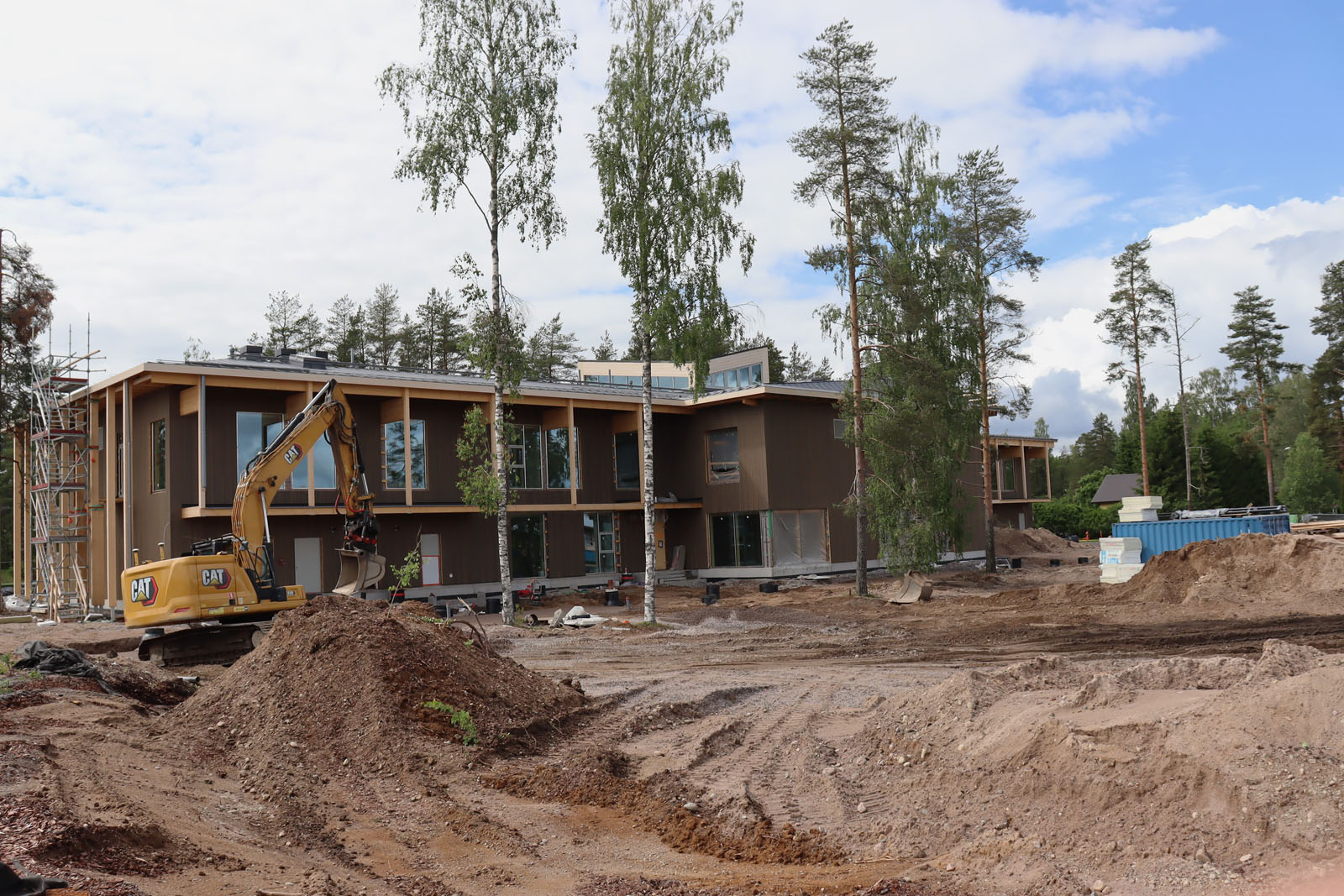

In May 2024, the construction of the new head office began in Vierumäki. The project is completed before the end of 2025. Demarcation of the construction site area. Start of earthworks.
The new wooden two-storey head office of 3,173 m2 and 15,700 m3 was completed in October 2025.
Versowood’s new head office was designed by Planetary Architecture, an expert in sustainable, environmentally friendly architecture. The new head office is a wooden pavilion in the forest, dominated by a wooden-pillar-beam frame that presents itself as an abstraction of the forest, both inside and outside the building.
The load-bearing frame structure of the building, including the intermediate floor and roof, is made of Versowood glulam, and Versowood Kuningaspaneeli was used as the facade cladding. The systemic and flexibly customisable office building is sprinkler-free and has received Leed Platinum certification.
The head office also serves as a pilot site for new types of glulam-structured joints and a customisable wooden office concept. Nearly a thousand cubic metres of glulam have been used for the frame structures, where the glulam serves as a long-term carbon store throughout the building’s life cycle. The glulam beams were machined using the glulam factory’s CNC machine, which speeds up installation work on site.
Design: Planetary Architecture, Architect Pekka Pakkanen, Developer: Varte Lahti Oy, Interior Design Studio Joanna Laajisto, Interior Designer Joanna Laajisto.
For more information about our wood construction products, please contact us at contact@versowood.fi. You can also read more about our other wood construction reference projects in our catalogue.
Our office facility experience survey was carried out in cooperation with Rune&Berg Design in March 2021. The survey was carried out to support the design and decision-making regarding the new head office. Versowood’s employees were surveyed for different layers relevant to, for example, smooth flow of work, innovation, learning, attractiveness, commitment, motivation and well-being at work.
The carbon footprint of Versowood’s new head office has been calculated, and it is approximately 15 kgCO2e/m2/a. The figure is clearly below the future limit values for the carbon footprint of an office building in accordance with the Building Act.
The carbon footprint of the head office will be low throughout its life cycle, as its main structures are made of wood, which has a low carbon footprint. In addition, the building has good energy efficiency and solar panels are used to support the electricity production. Together, these reduce the need for purchased energy, which directly reduces emissions throughout the building’s life cycle. Furthermore, due to the large amount of wood, the carbon handprint of the building is considerably high, approximately 10 kgCO2e/m2/a. Carbon handprint refers to positive environmental impacts.
The carbon footprint calculation was carried out by Sweco, using the One Click LCA software. You can read more in this report.
****************************************************************
The carbon footprint of the Versowood new head office has been calculated and is approximately 15 kgCO2e/m2,a. The figure is clearly below the future limit values for the carbon footprint of an office building according to the Finnish Construction Act.
The carbon footprint of the head office will be small due to its main structures being made of wood, which has a low carbon footprint. In addition, the building is energy efficient, and solar panels are used to generate electricity. Together, these reduce the need for purchased energy, which directly reduces emissions during the building's life cycle. Due to the large amount of wood used in construction, the building's carbon handprint is also considerably large, approximately 10 kgCO2e/m2,a. Carbon handprint refers to the building’s positive environmental impacts.
The carbon footprint calculation was carried out by Sweco using the One Click LCA software. Read more:

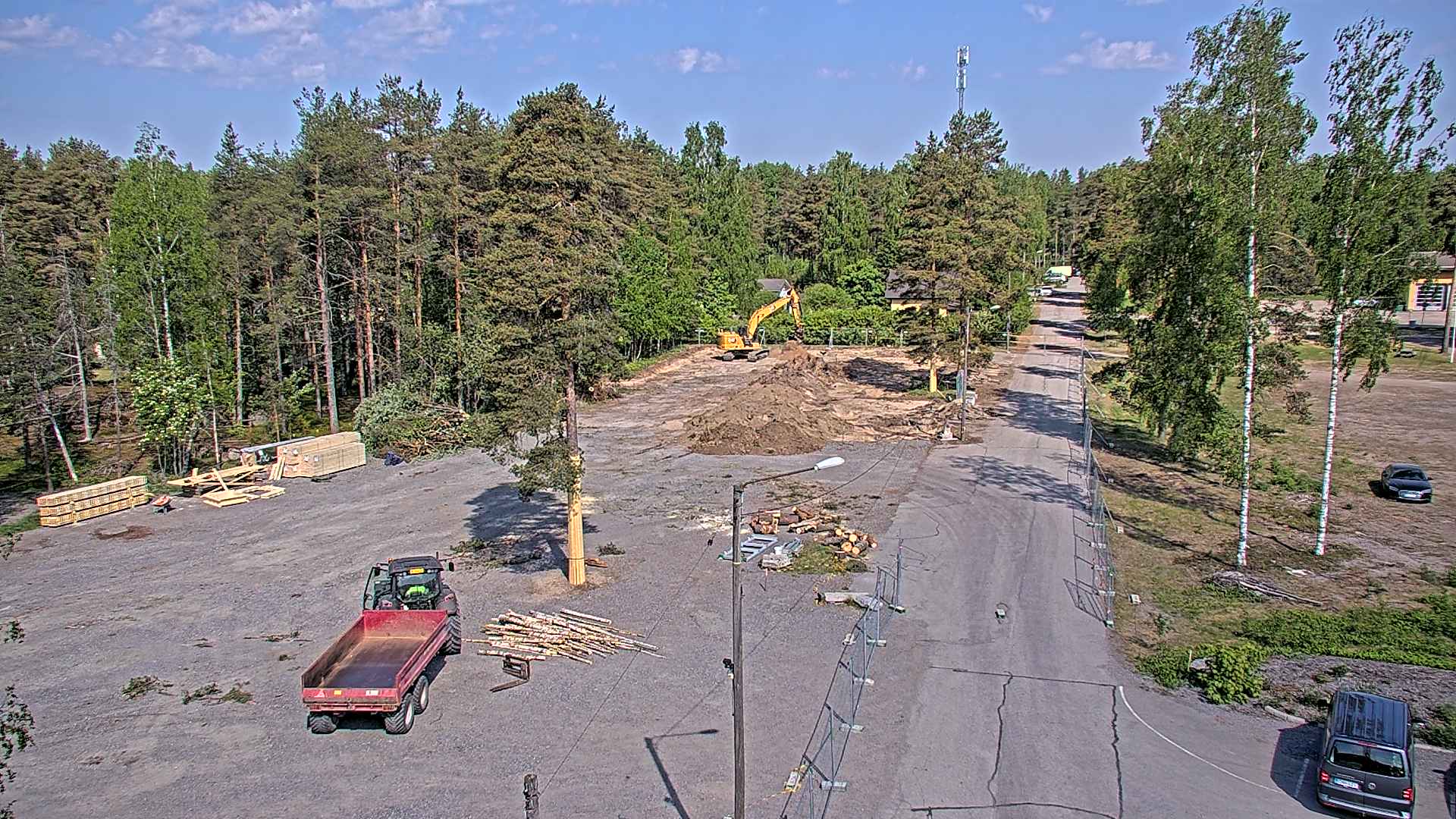

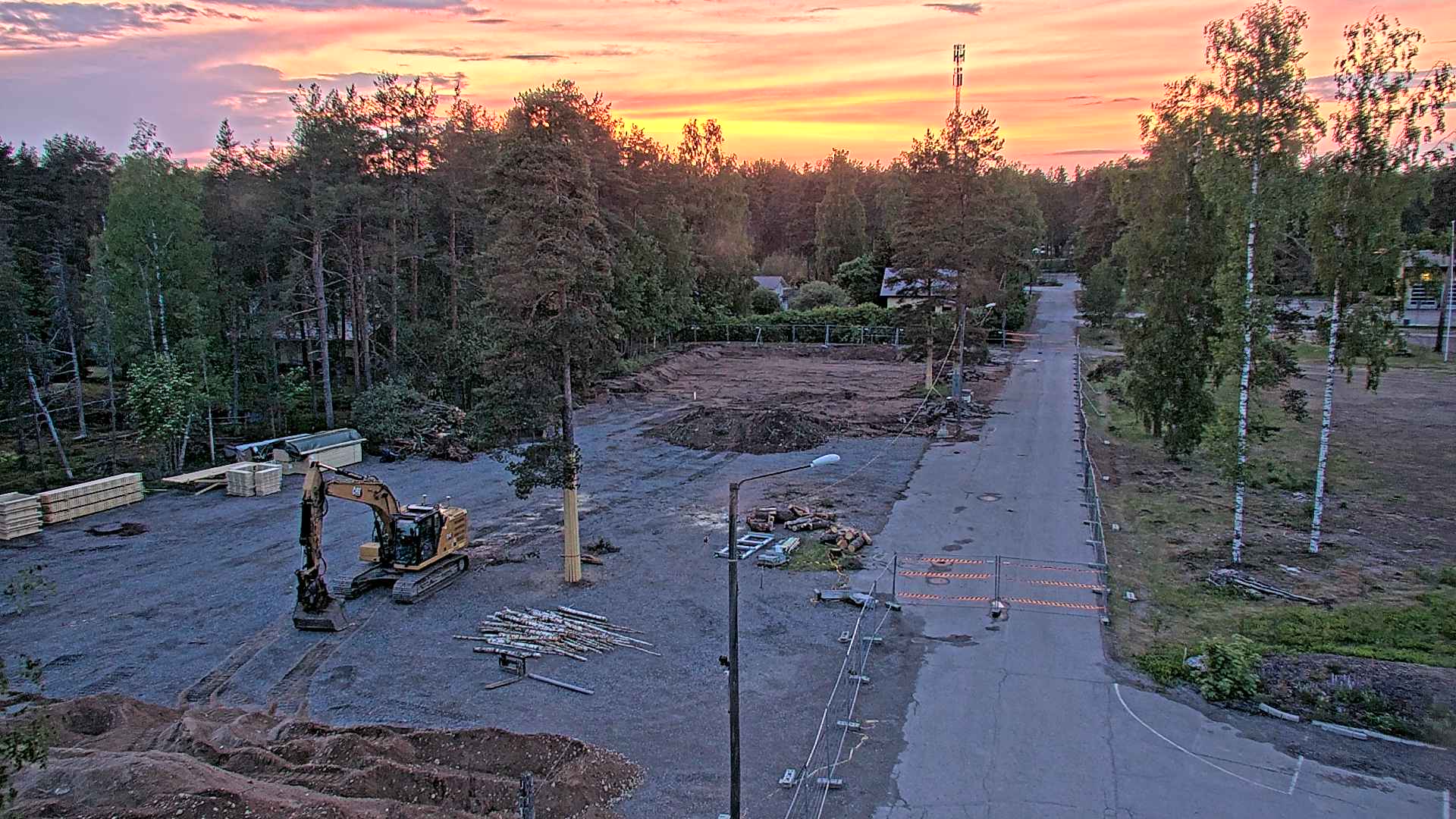

In May 2024, the construction of the new head office began in Vierumäki. The project is completed before the end of 2025. Demarcation of the construction site area. Start of earthworks.

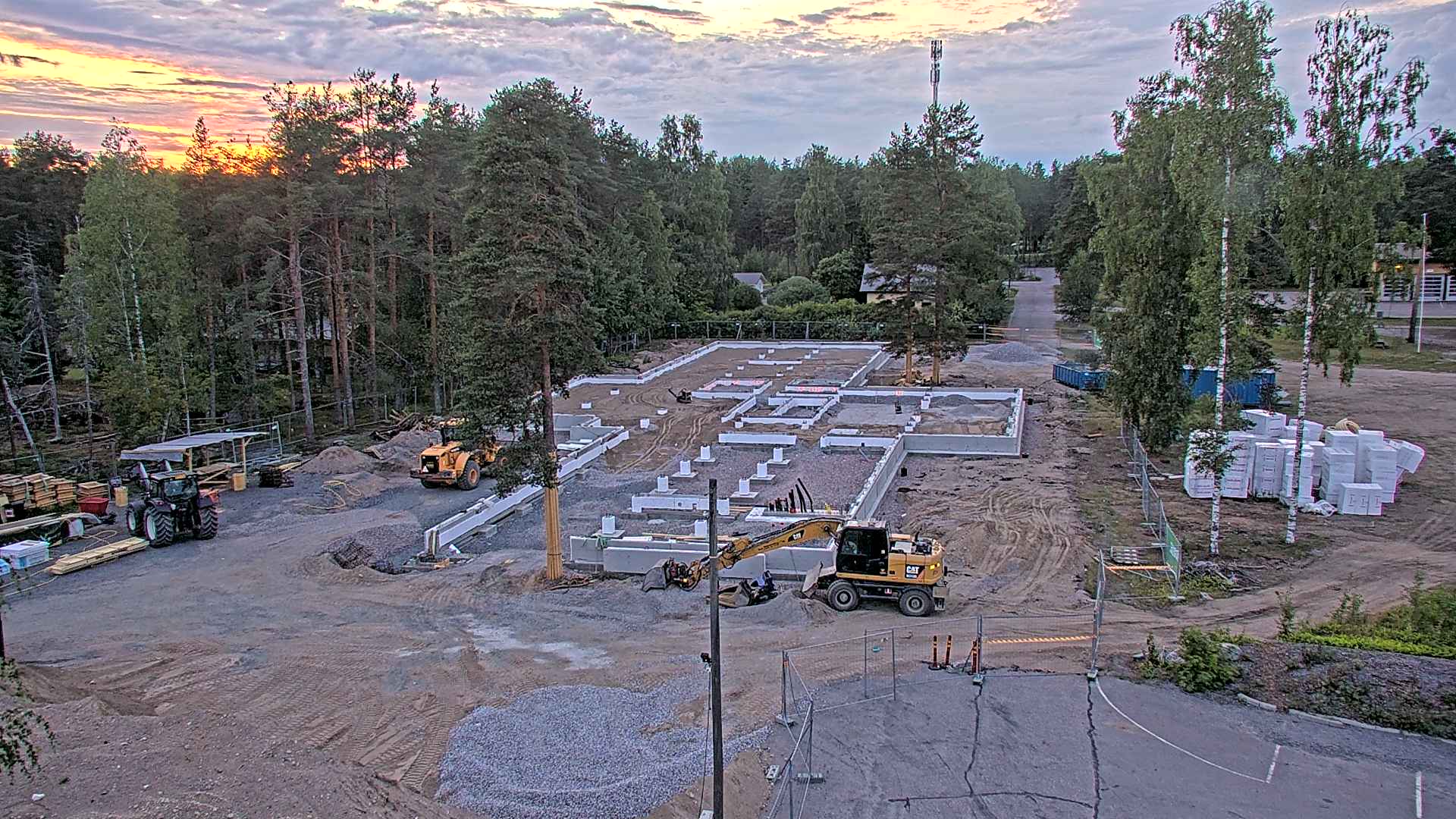

Work on the foundation casting moulds continues.

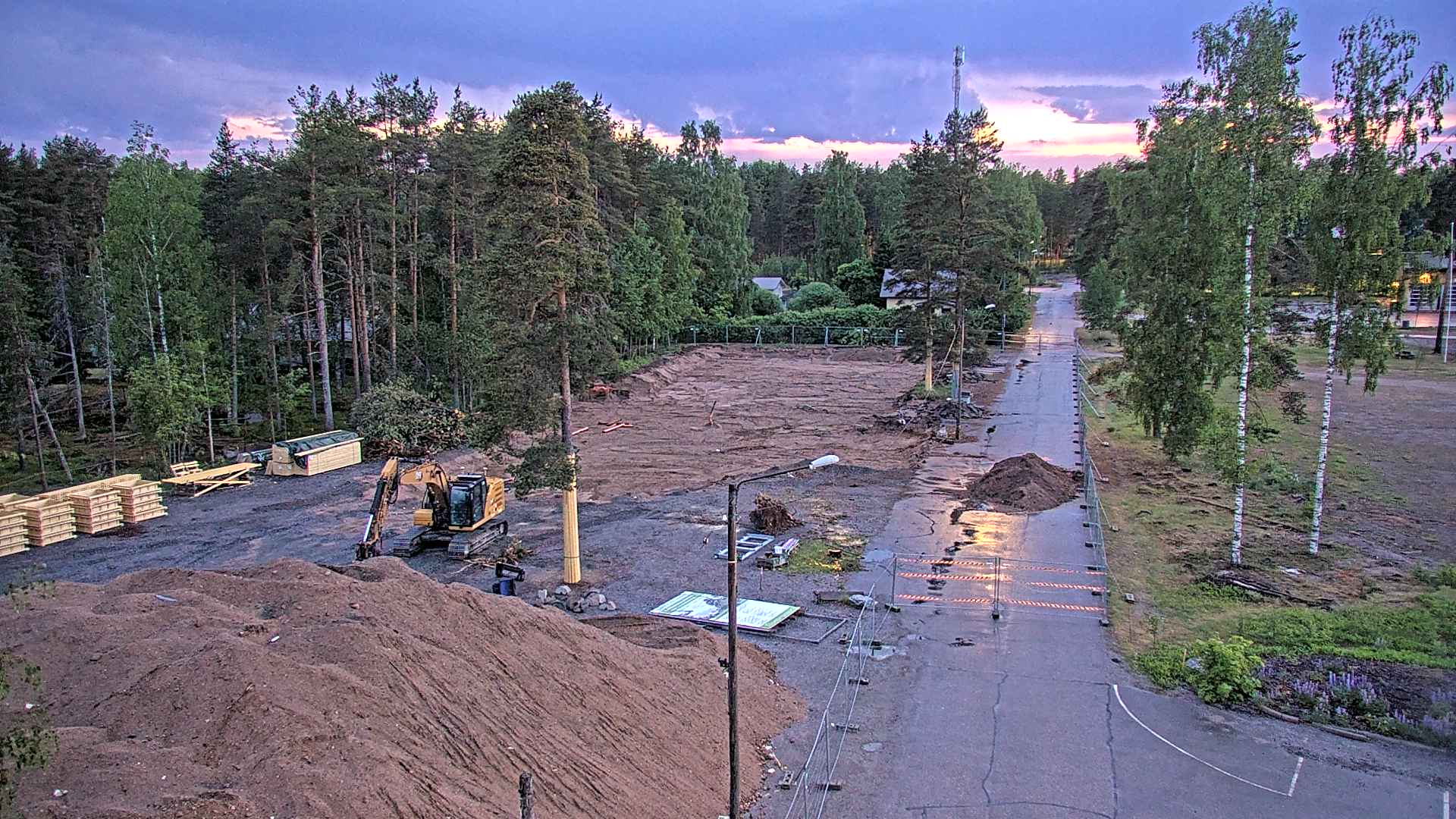

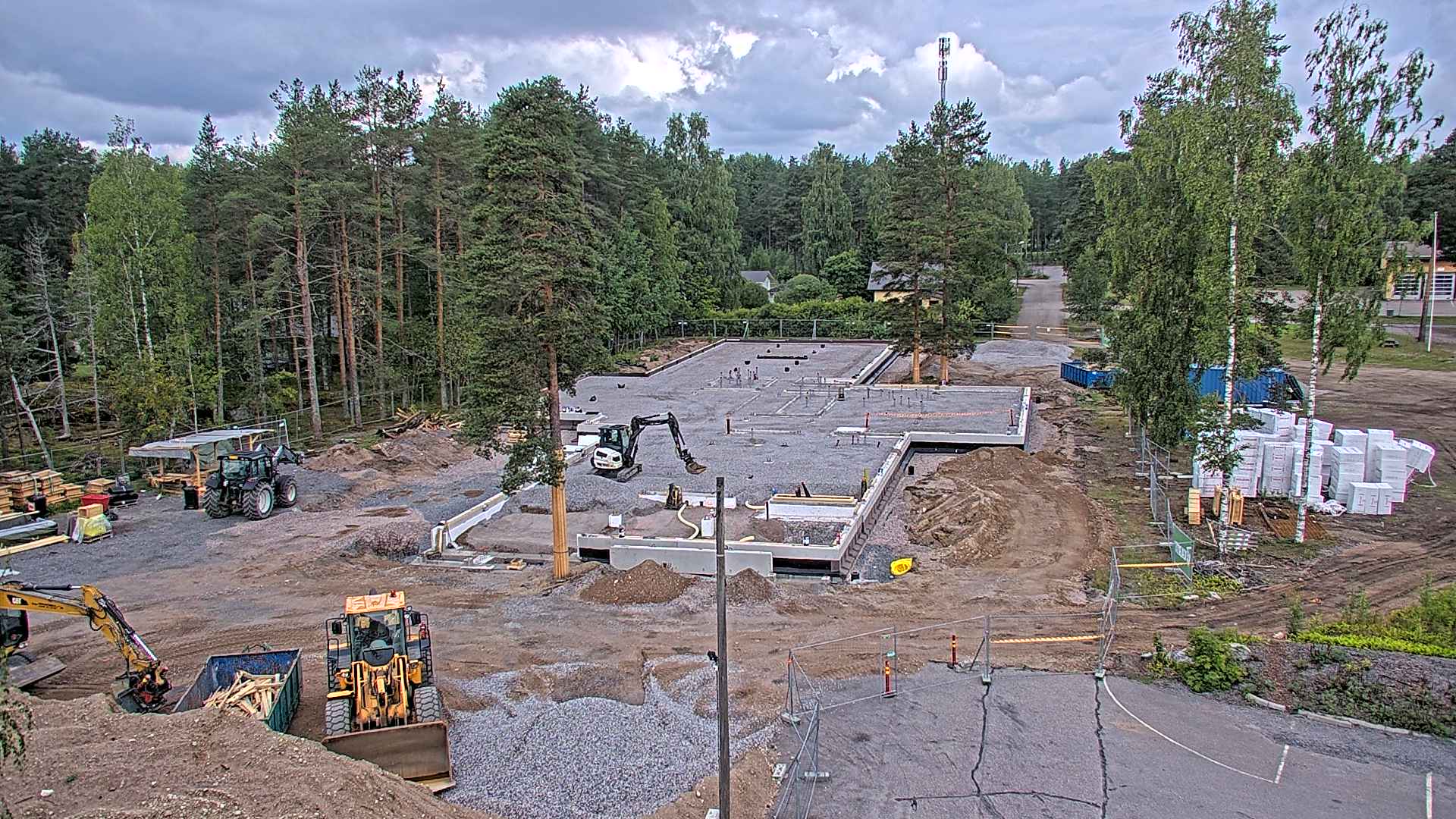

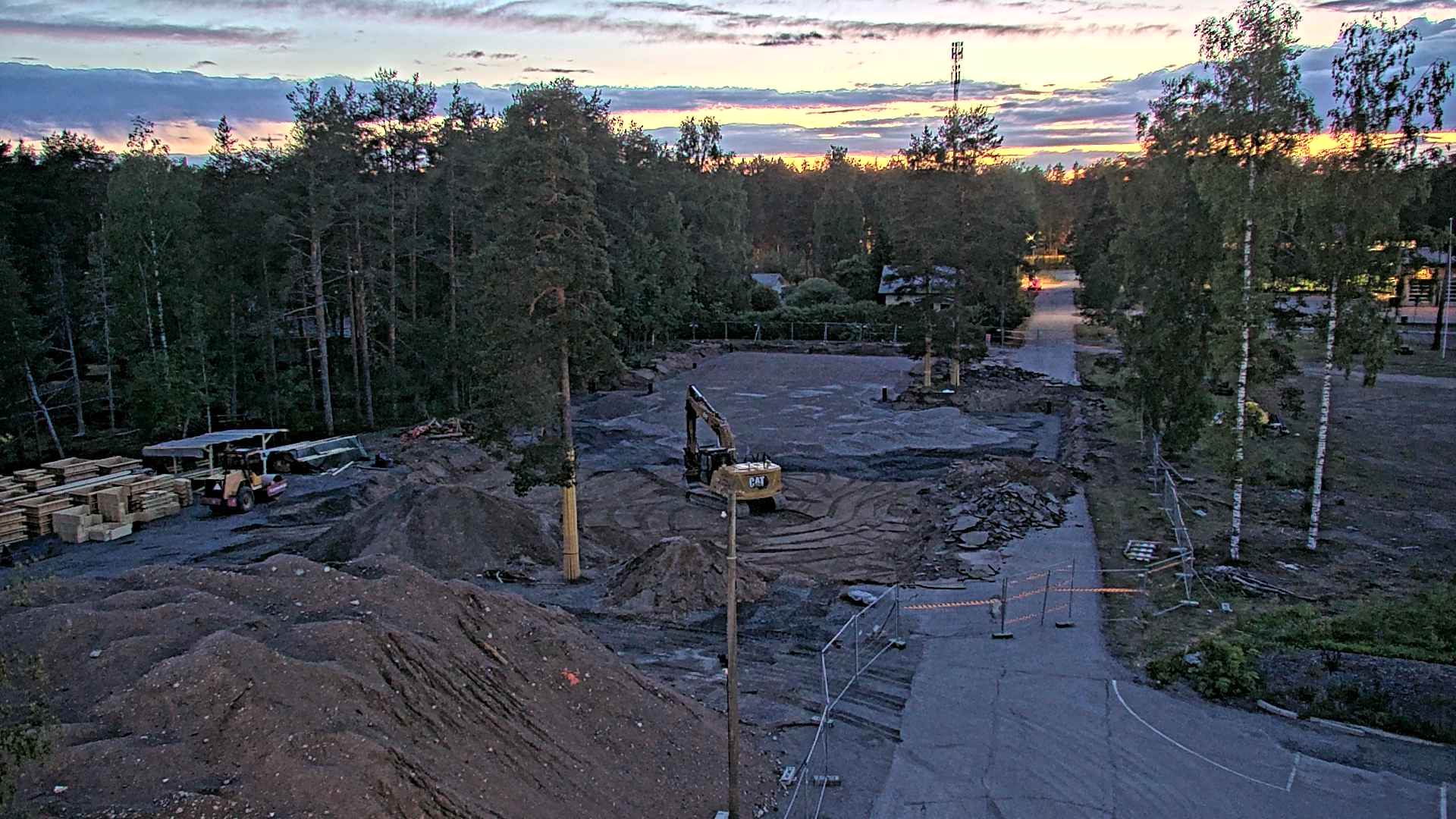

The foundation work continues.

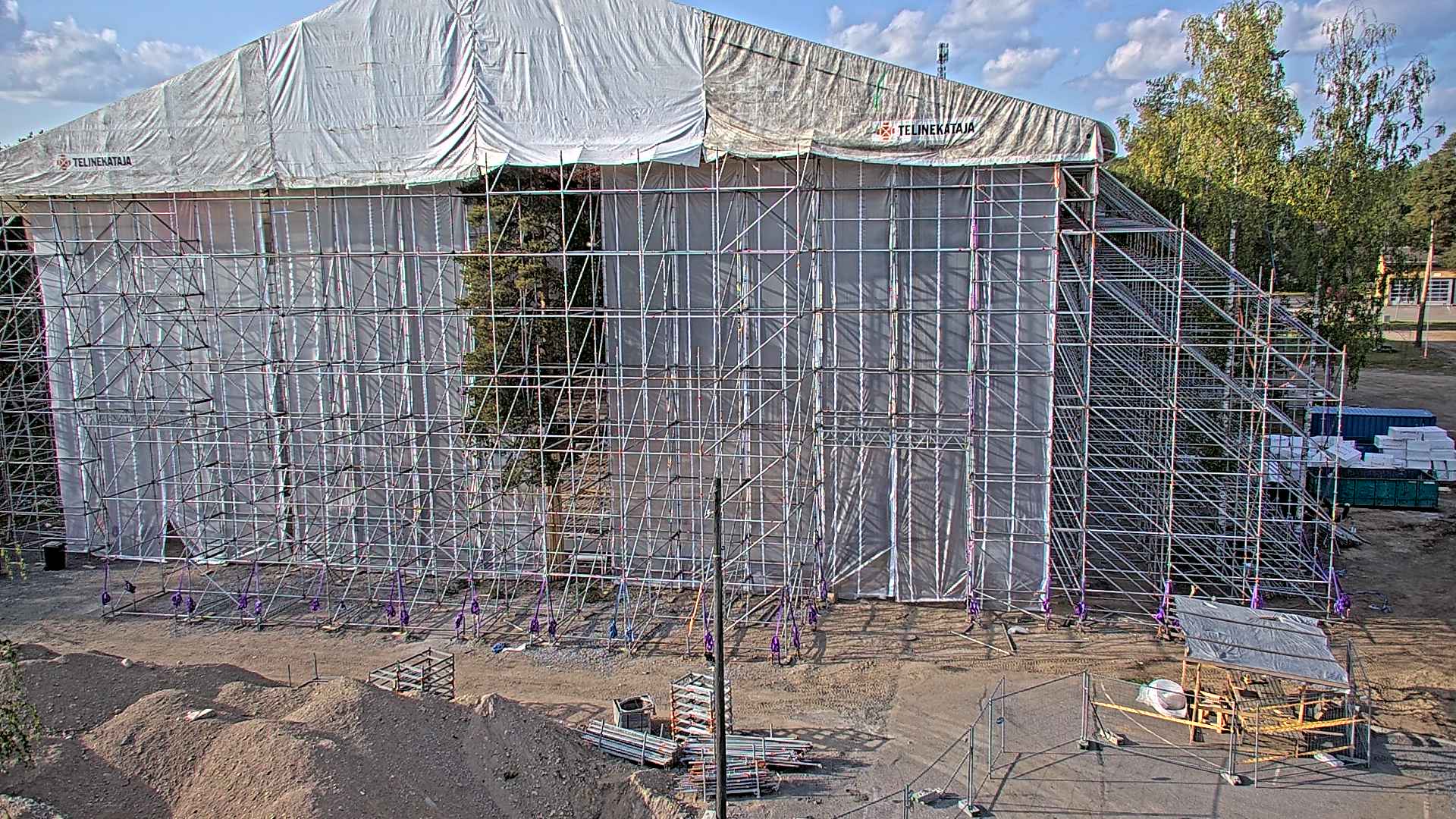

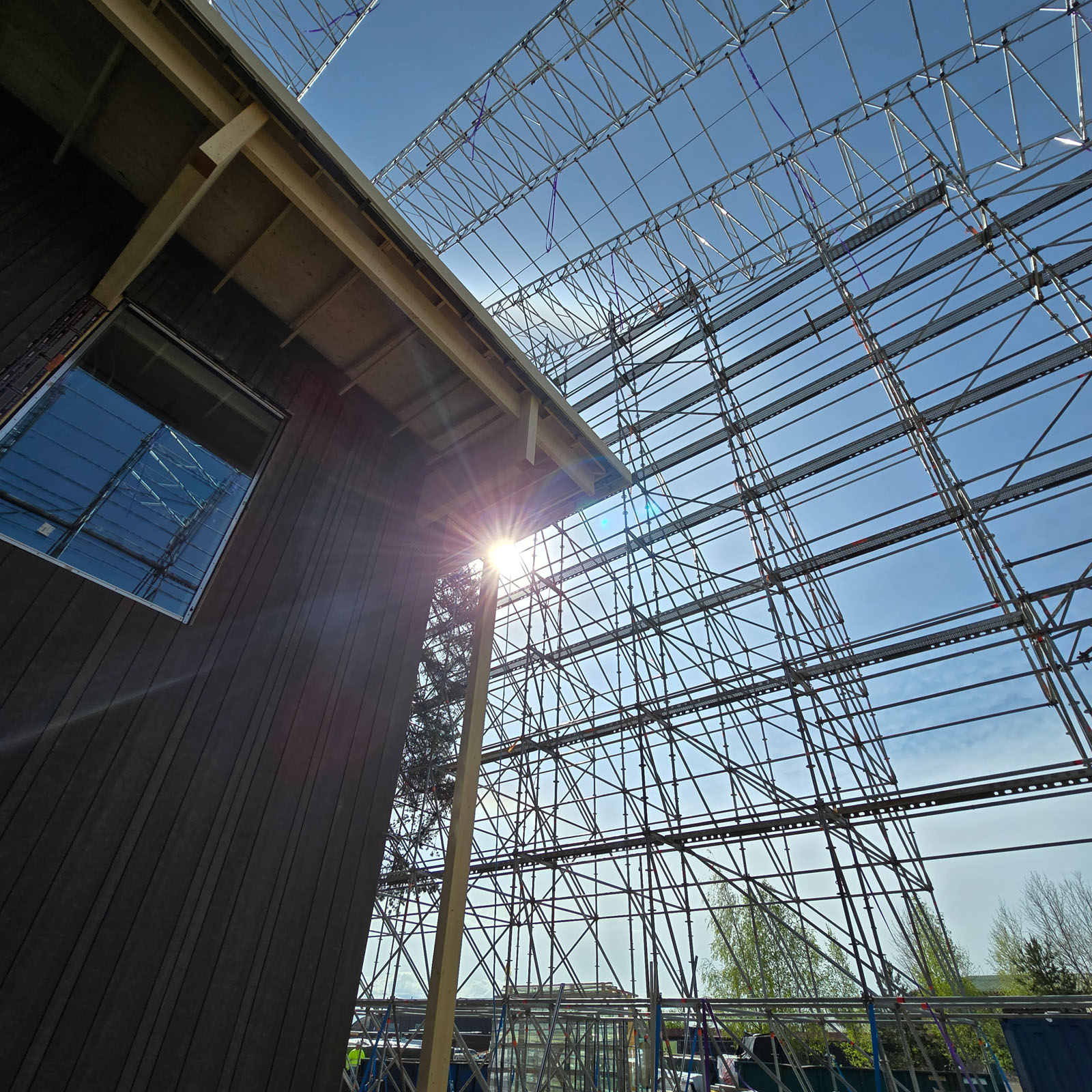

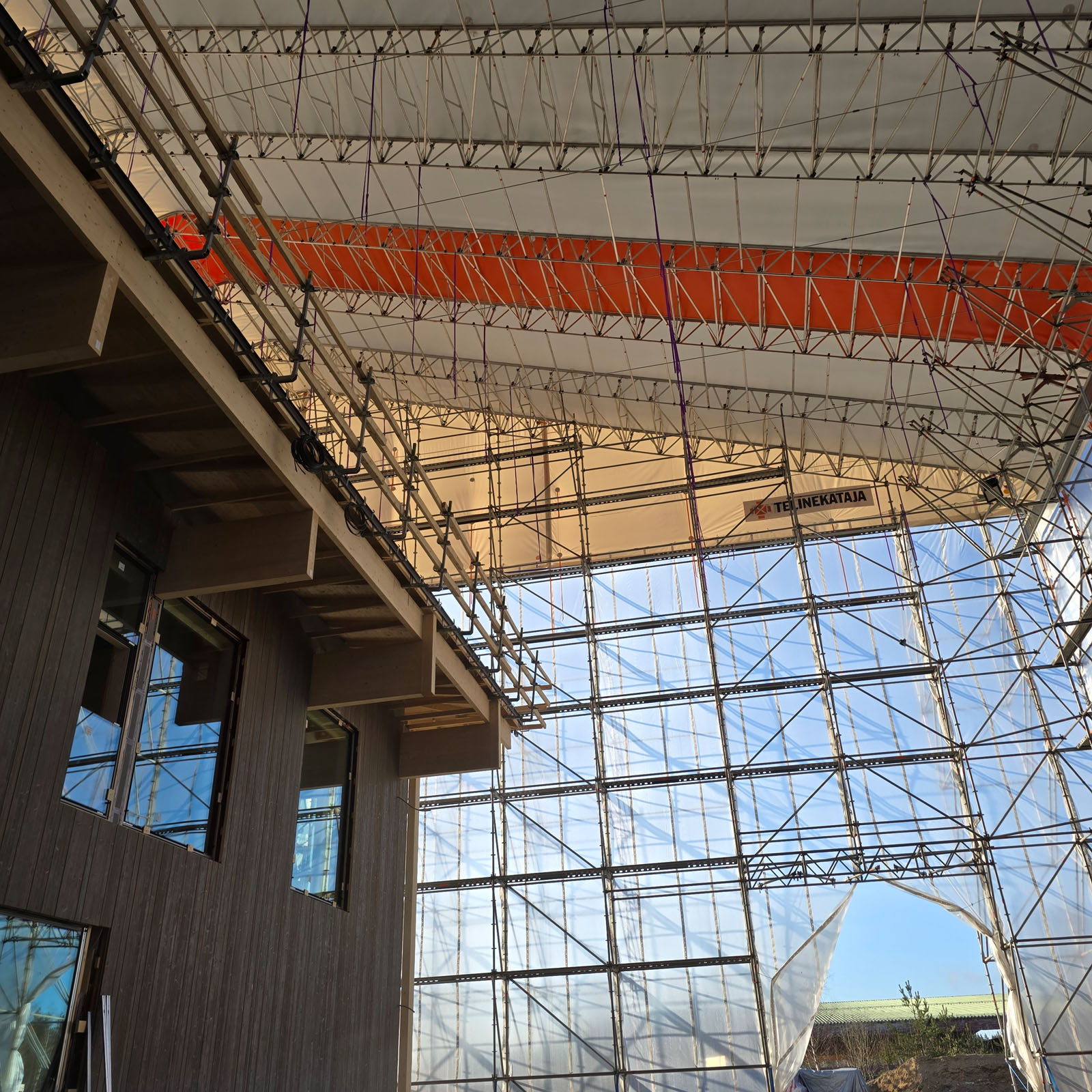

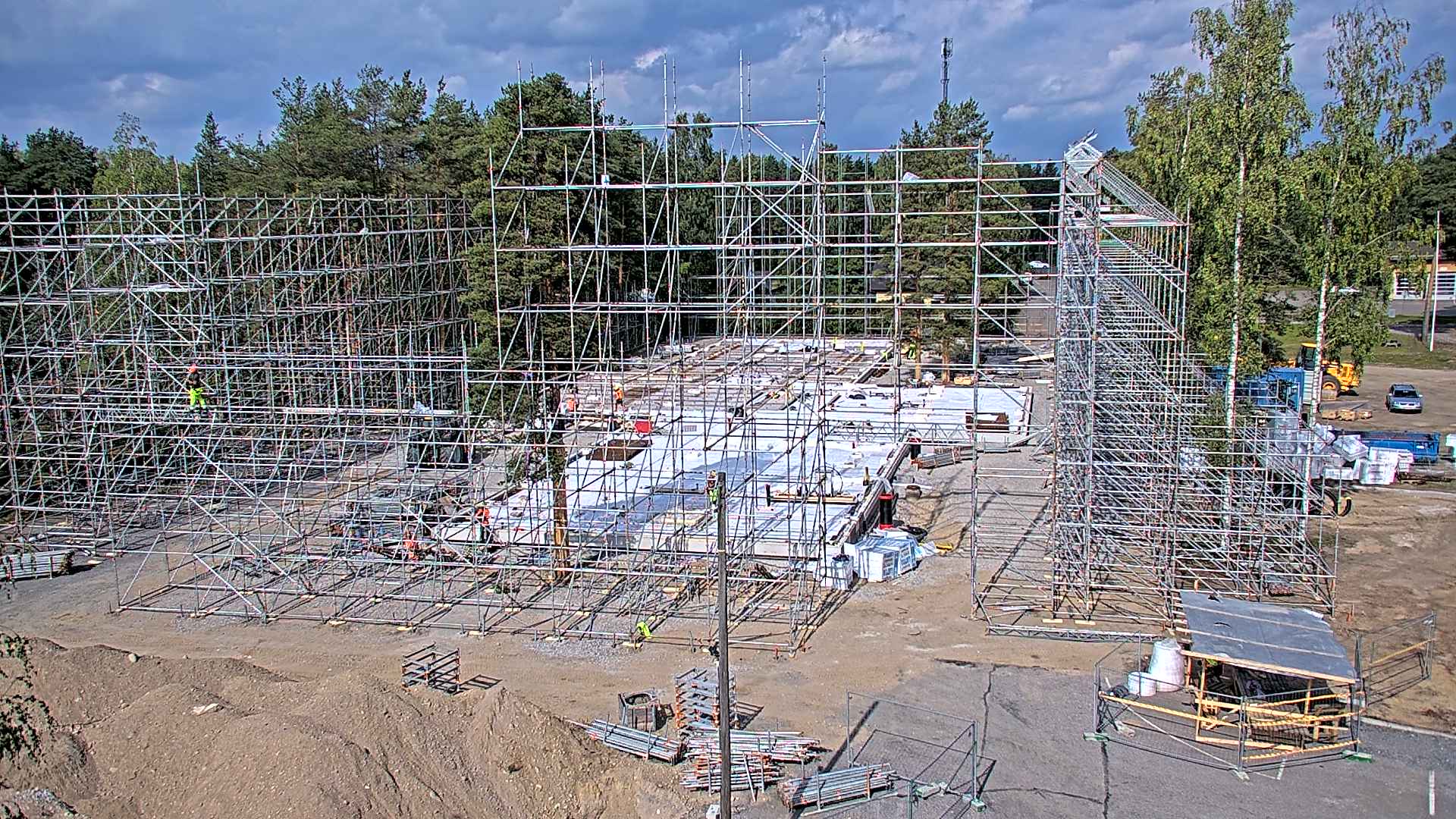

Installation of scaffolding and weather protection, excavation work.

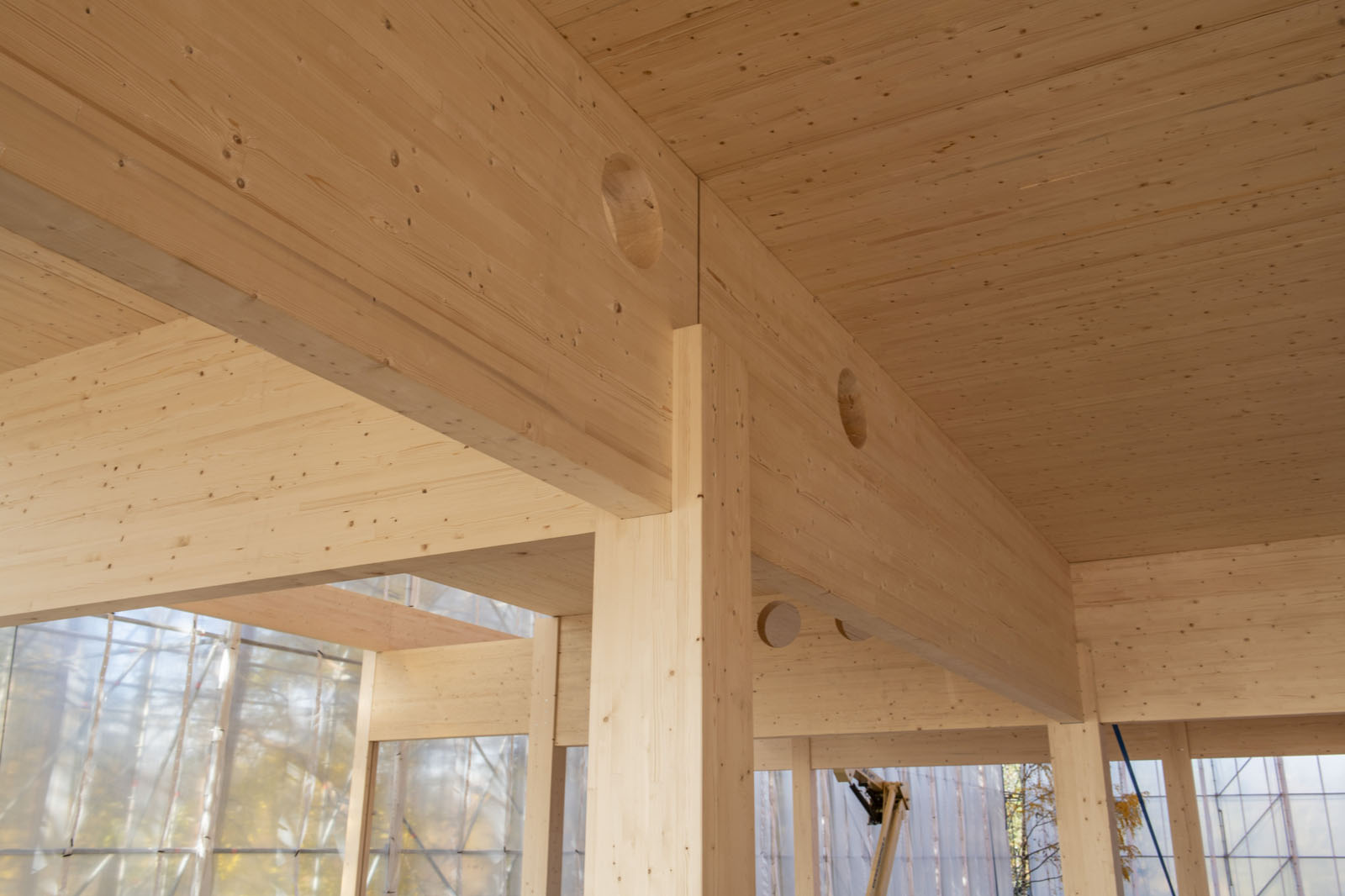

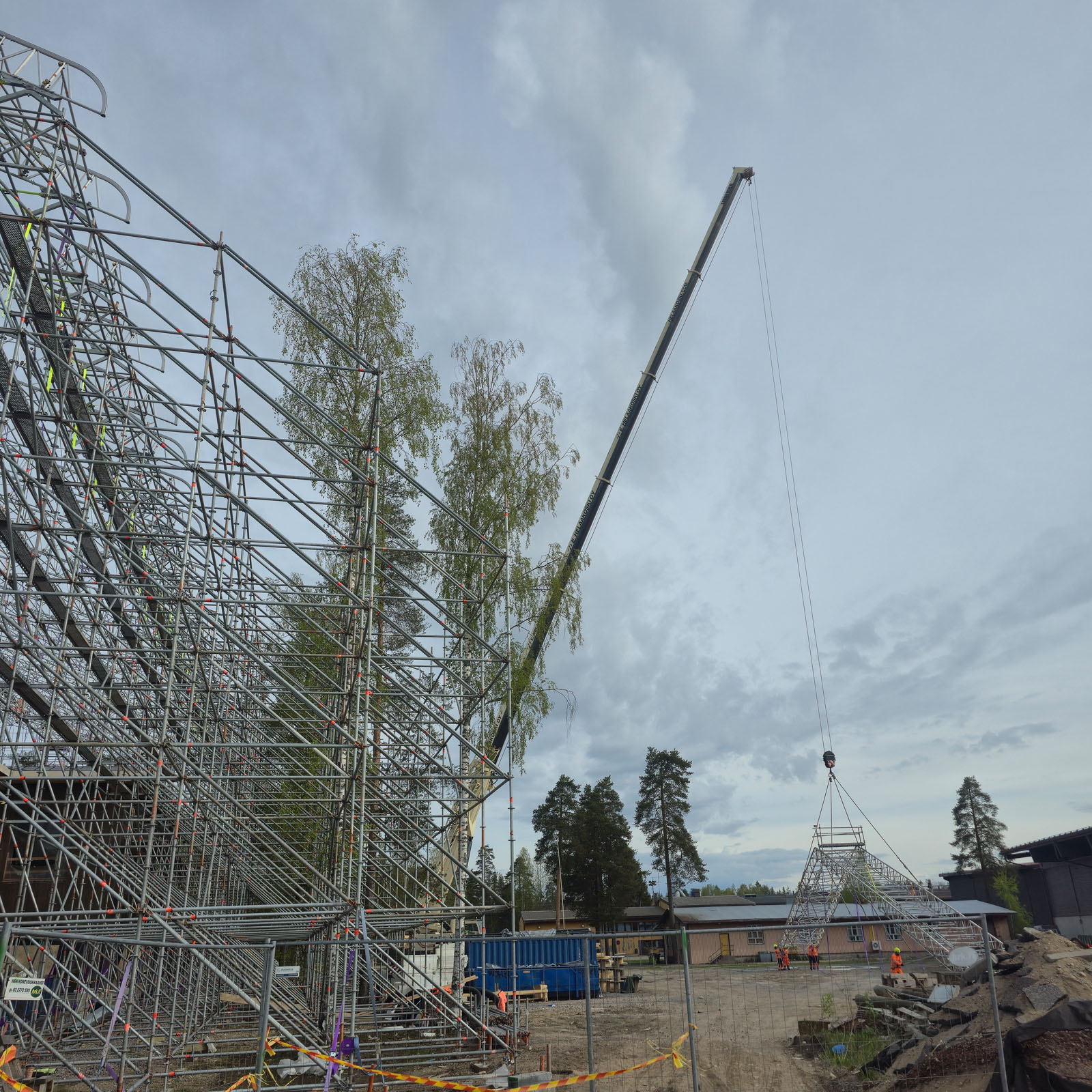

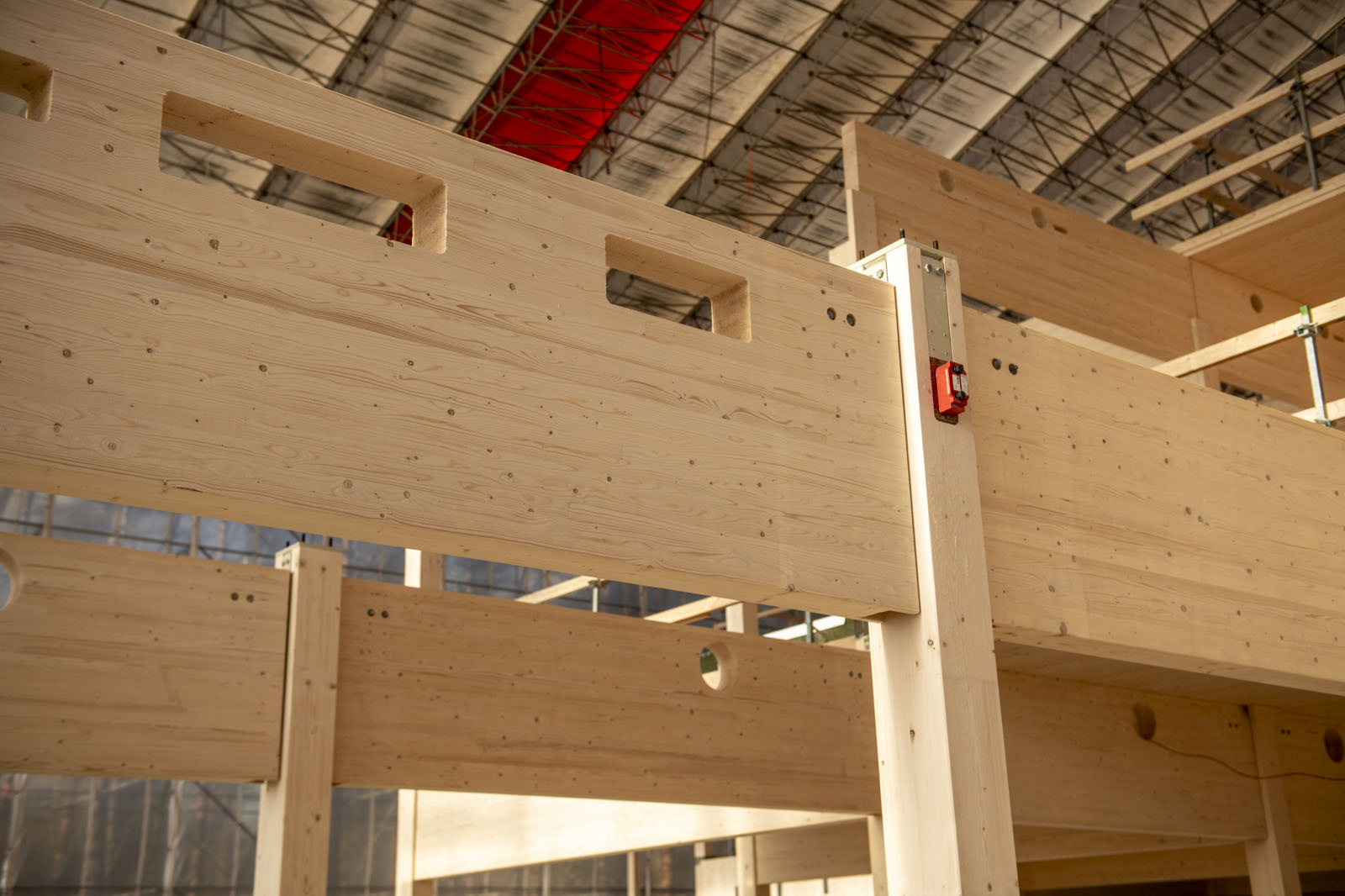

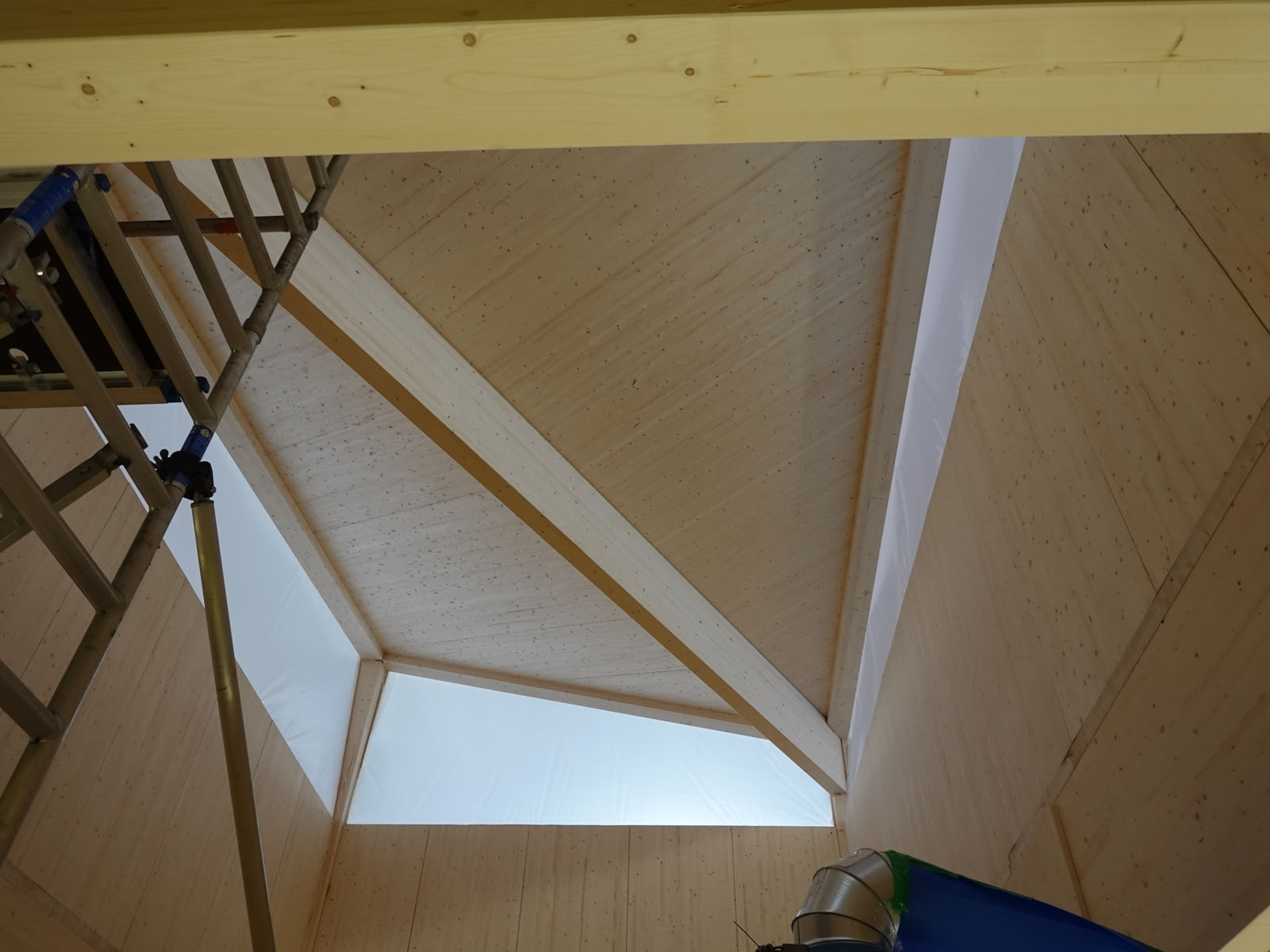

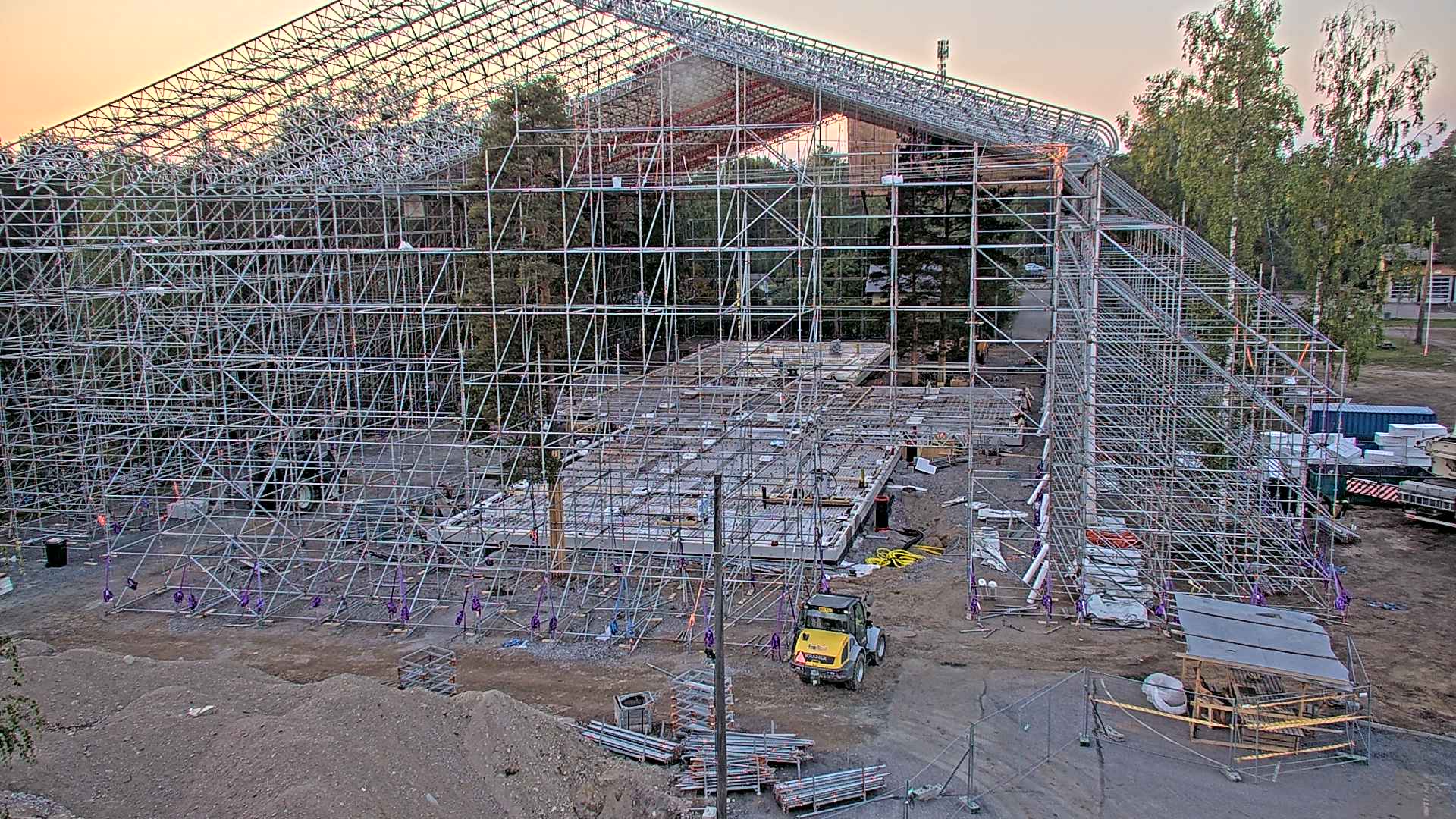

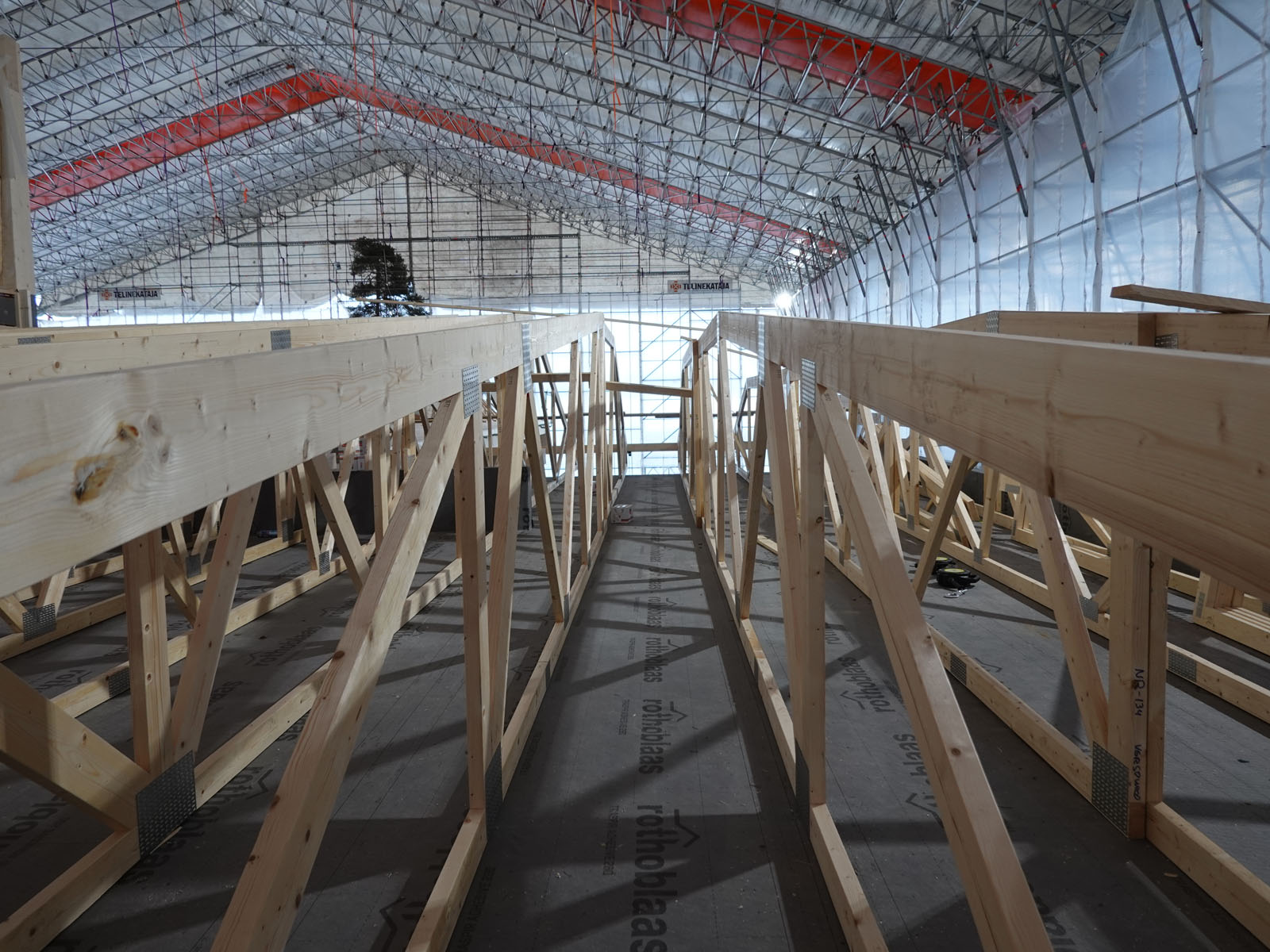

Manufacture and machining of glulam at the glulam plant. Installation of the glulam frame, woodwork on the roof, district heating excavation and installation. The intermediate floors are made of solid glulam slabs.
Installation video for the glulam frame.

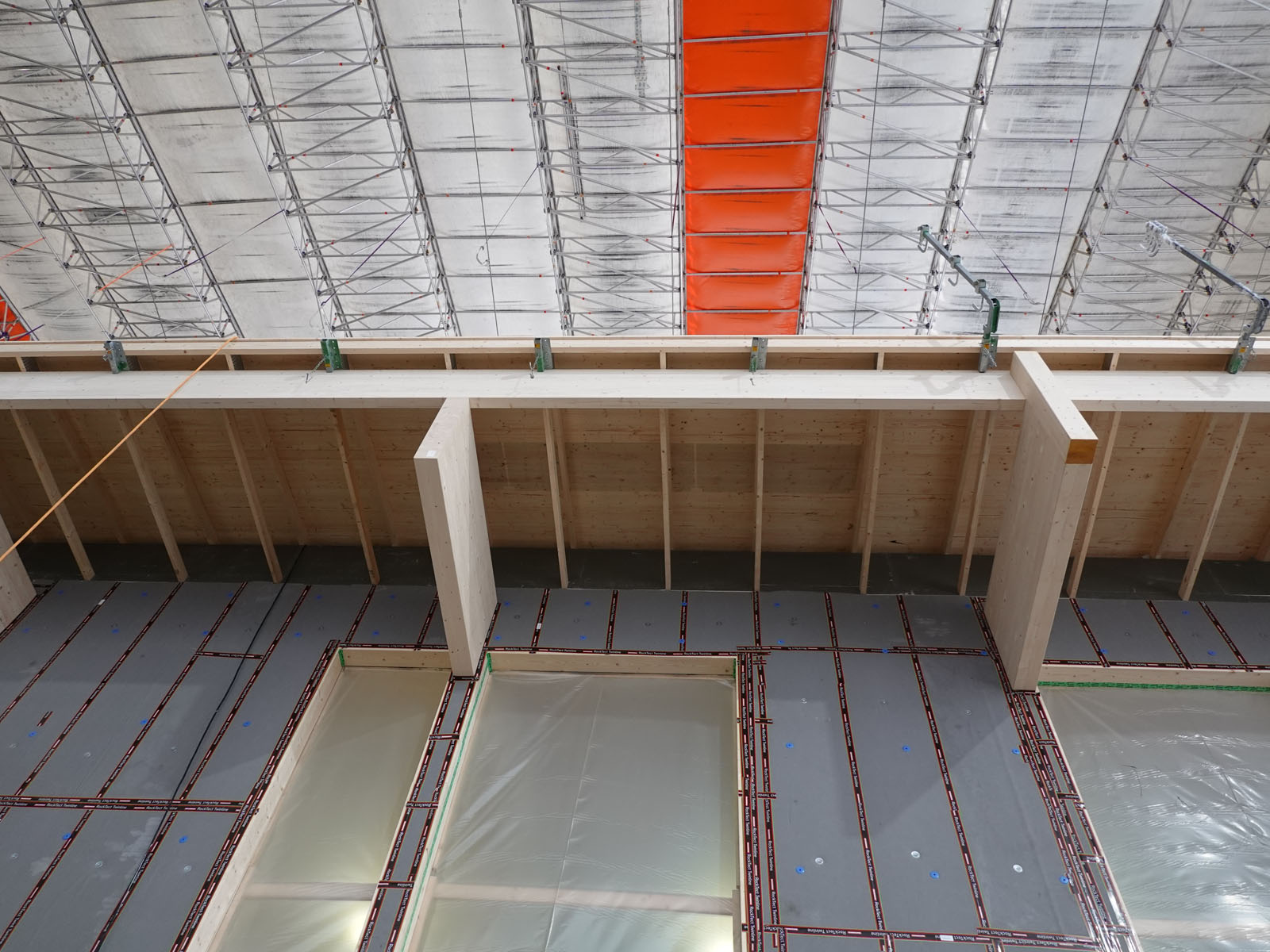

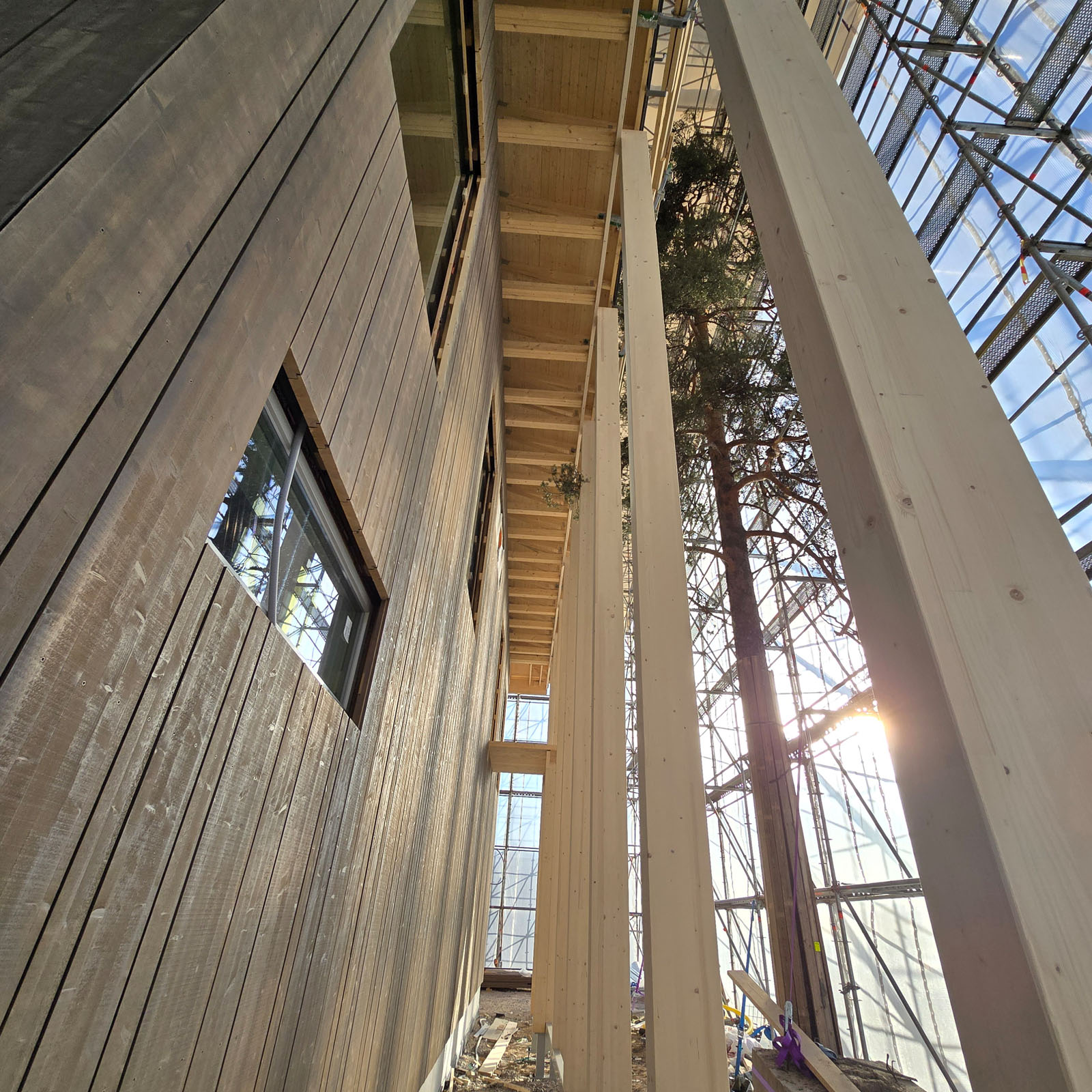

Installation of the wooden frame and woodwork on the roof continues, masonry of partition walls.

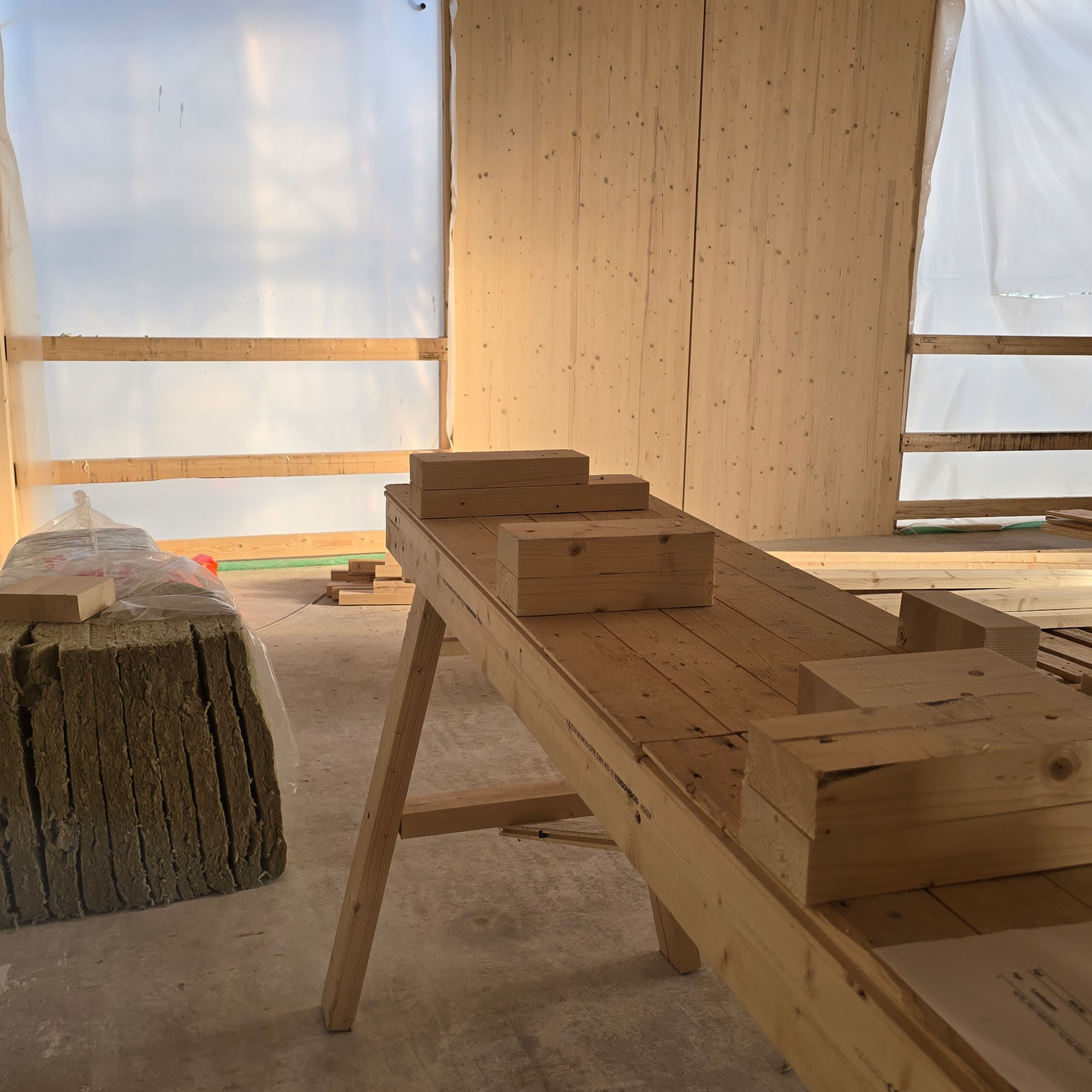

The installation of the wooden frame is for the most part complete. Masonry of the partition walls continues. Thermal insulation and panelling of exterior walls.

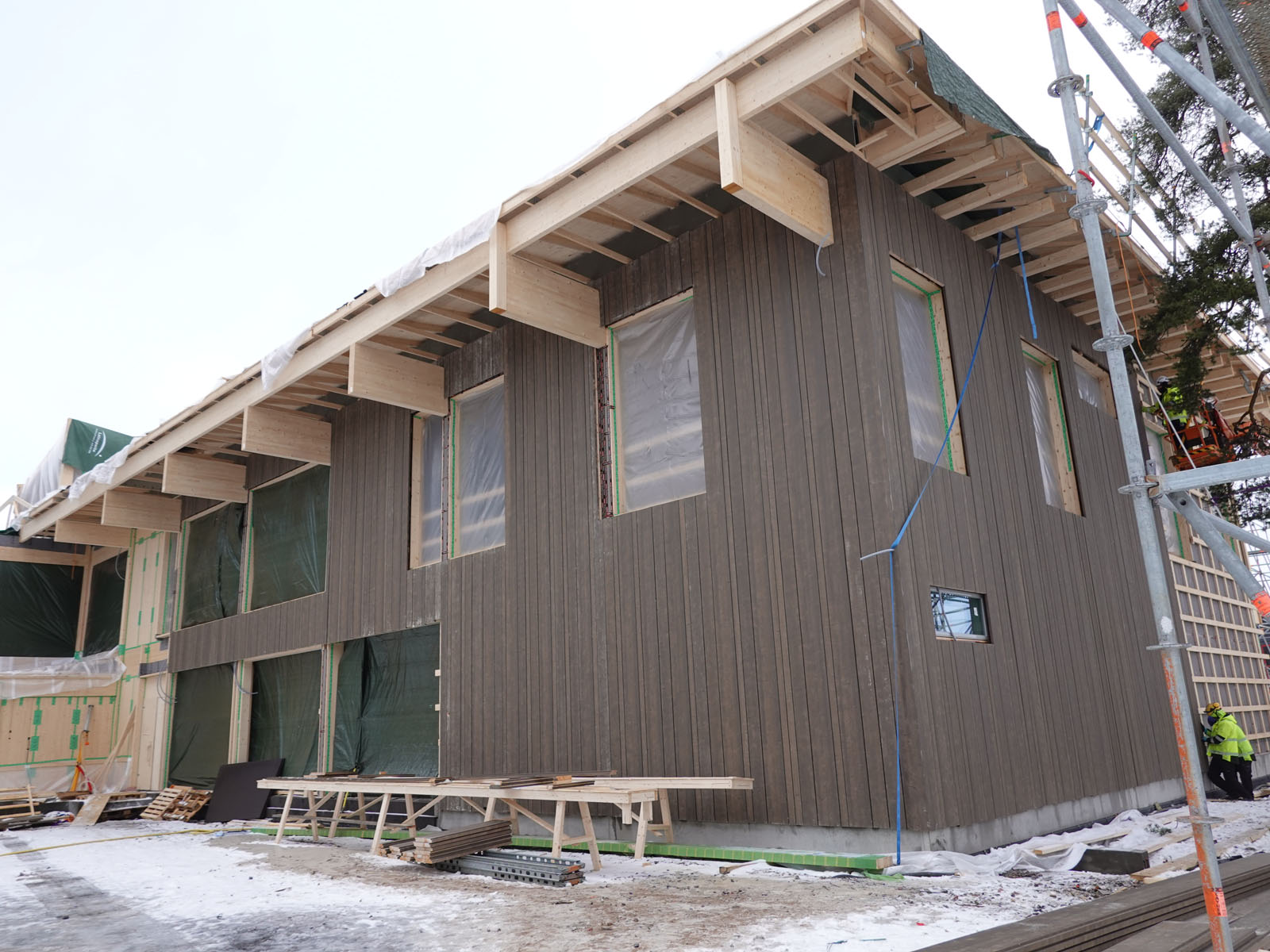

January 2025: Masonry of the partition walls is completed. Ongoing: assembly of weather protection, levelling and painting work, partition wall work, panelling of exterior walls, HVAC work, tiling work.

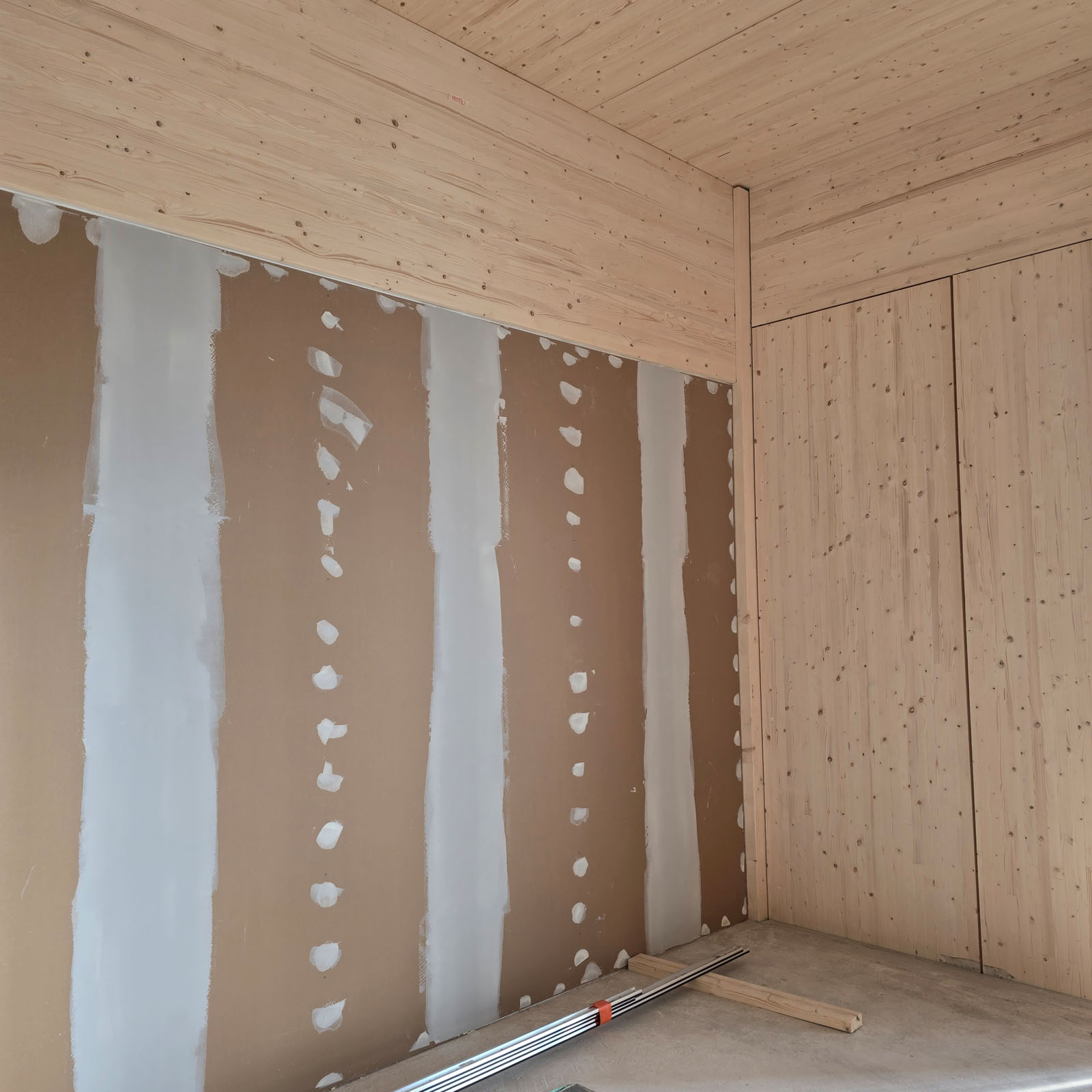

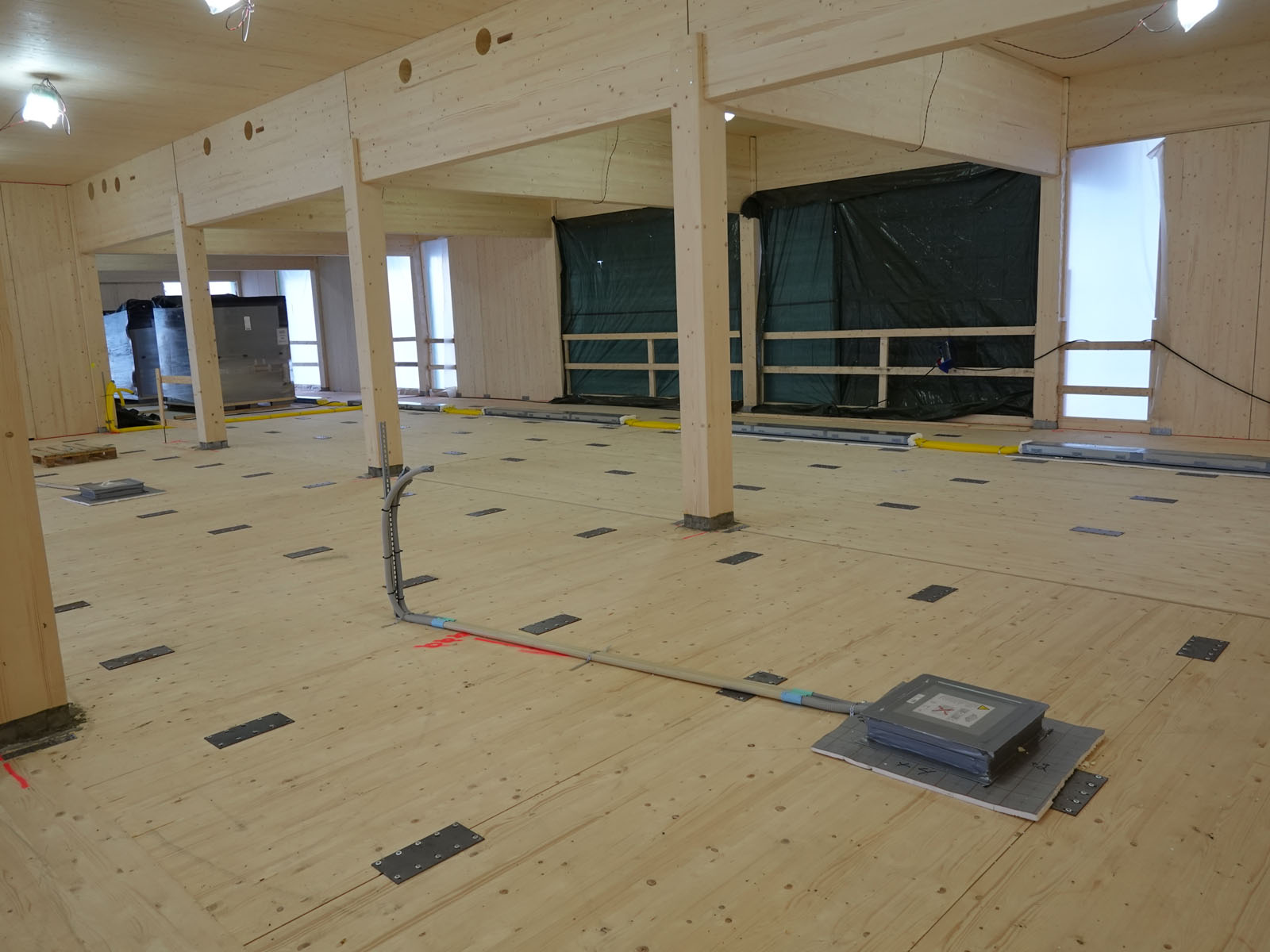

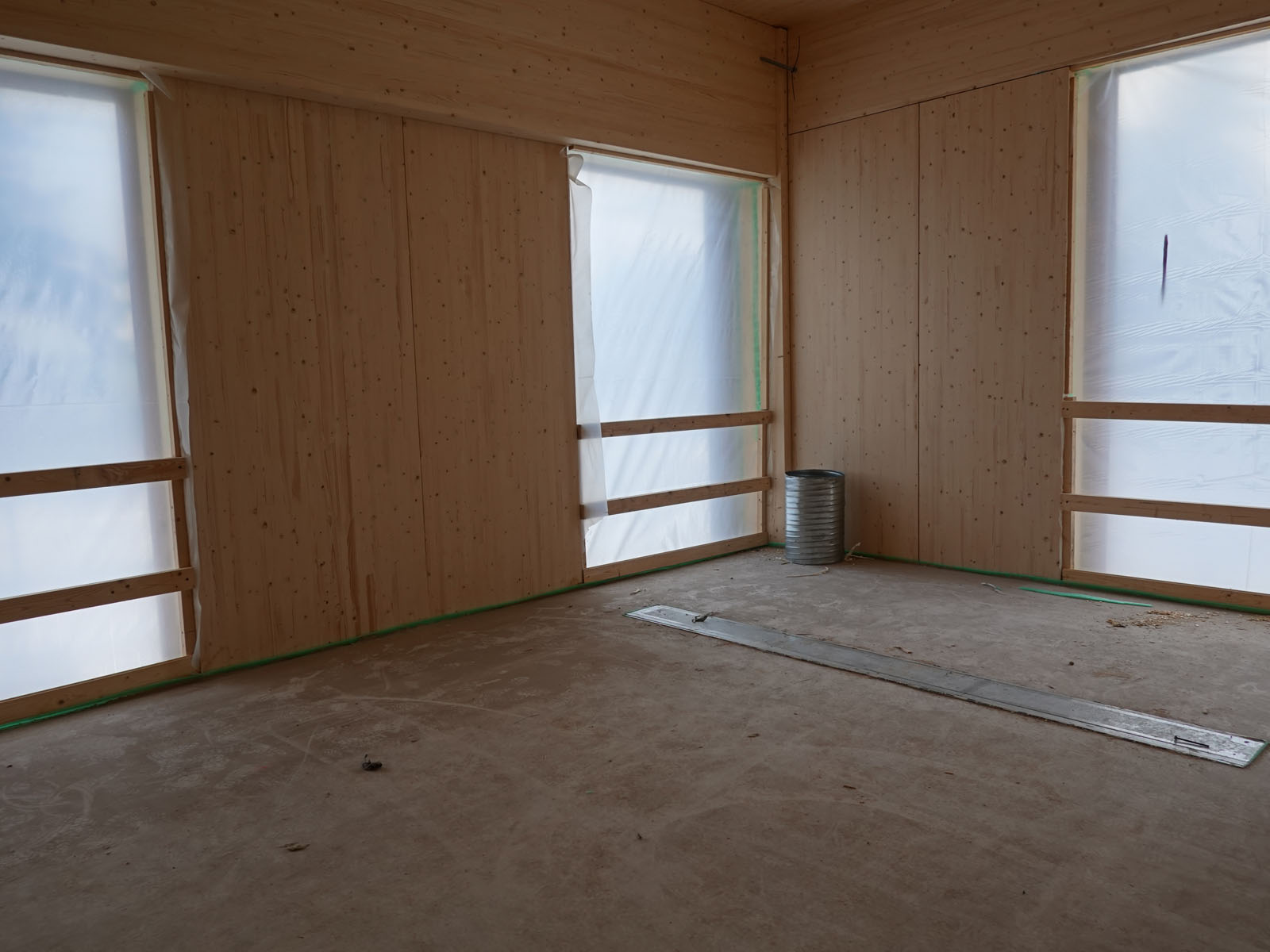

Installation of the wooden frame is for the most part completed. Partition wall masonry, partition wall work, taping of the exterior walls, thermal insulation and panelling, HVAC work, tiling work.

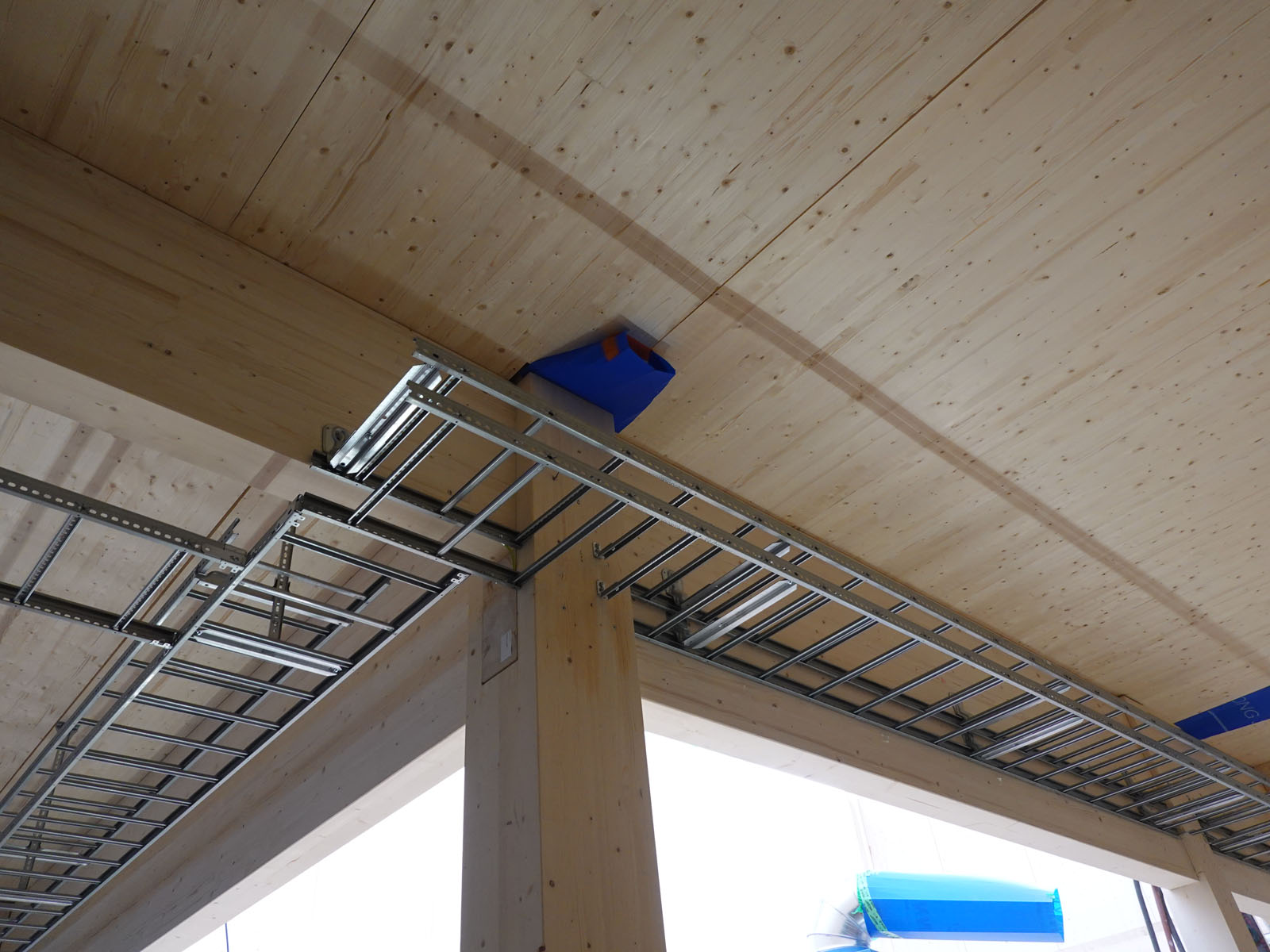

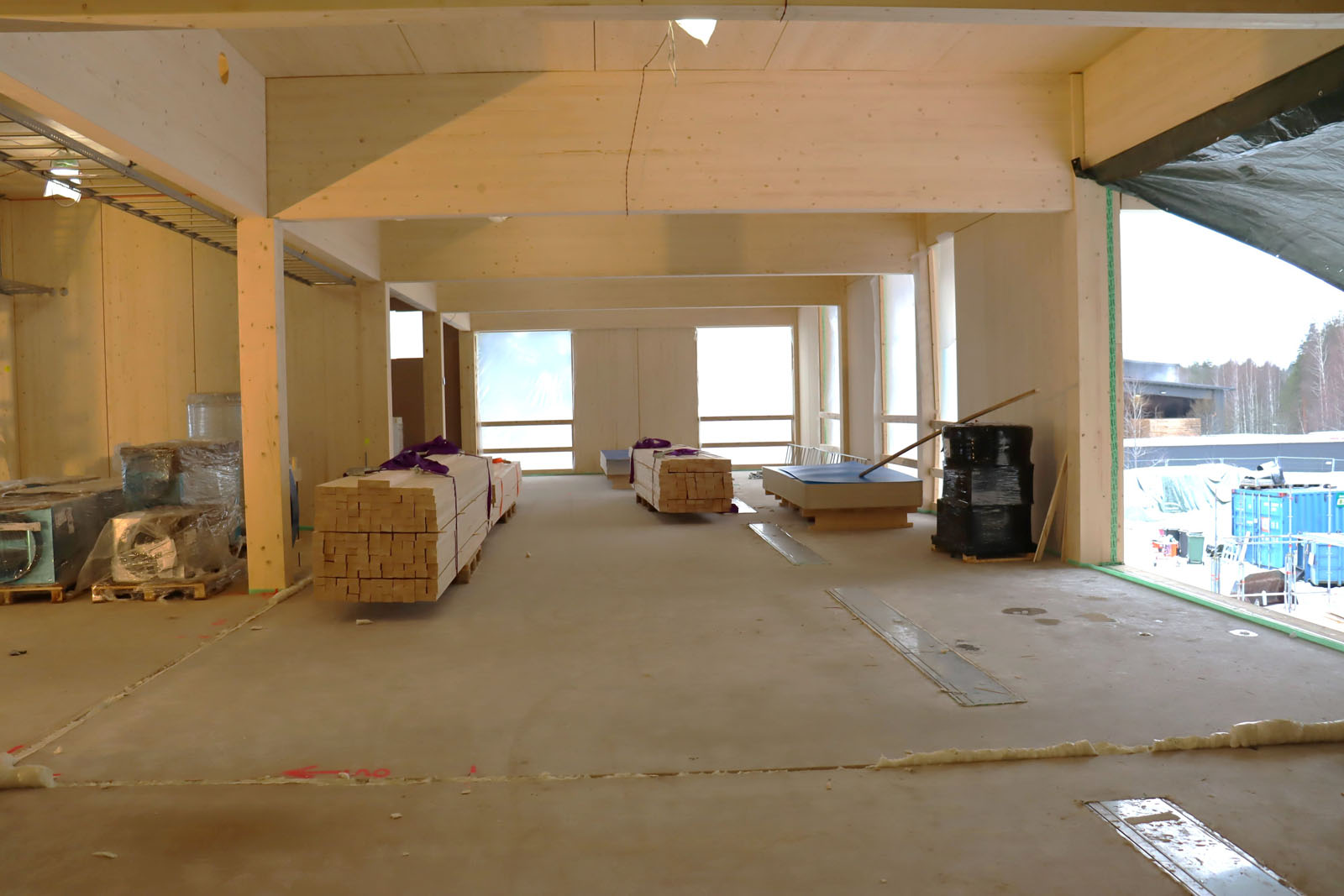

Panelling of exterior walls Kuningaspaneeli®, tiling work, levelling and painting work, HVAC work.

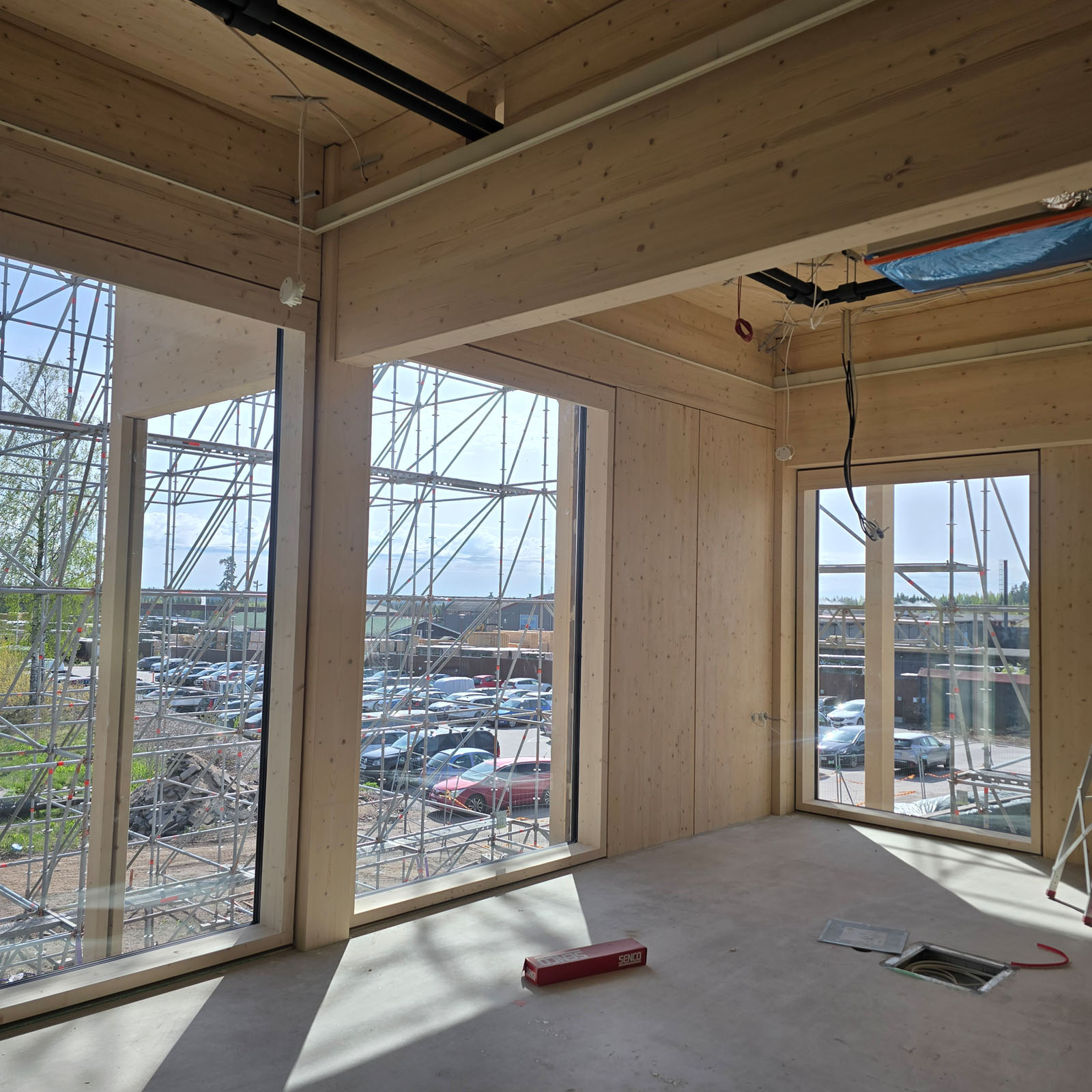

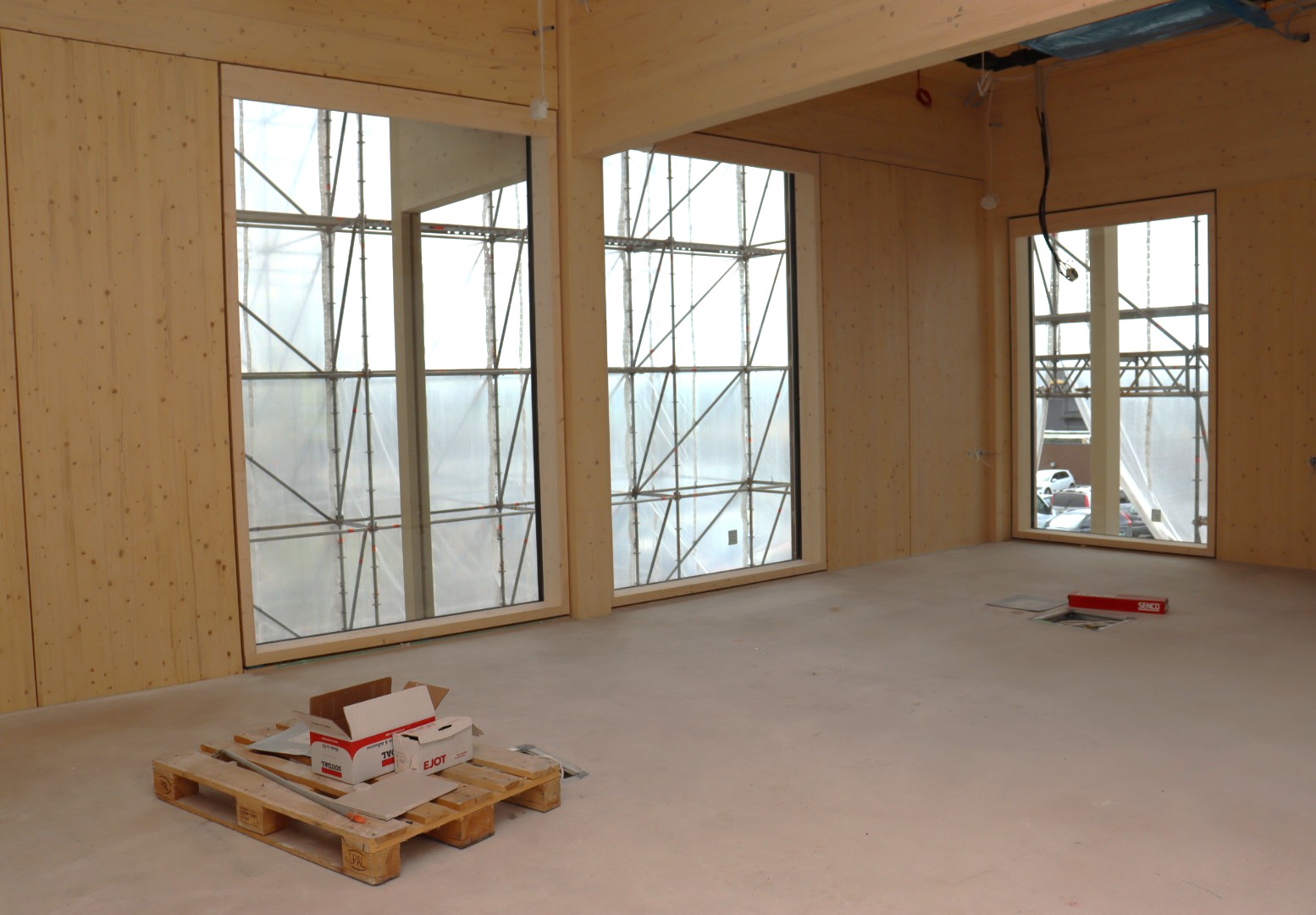

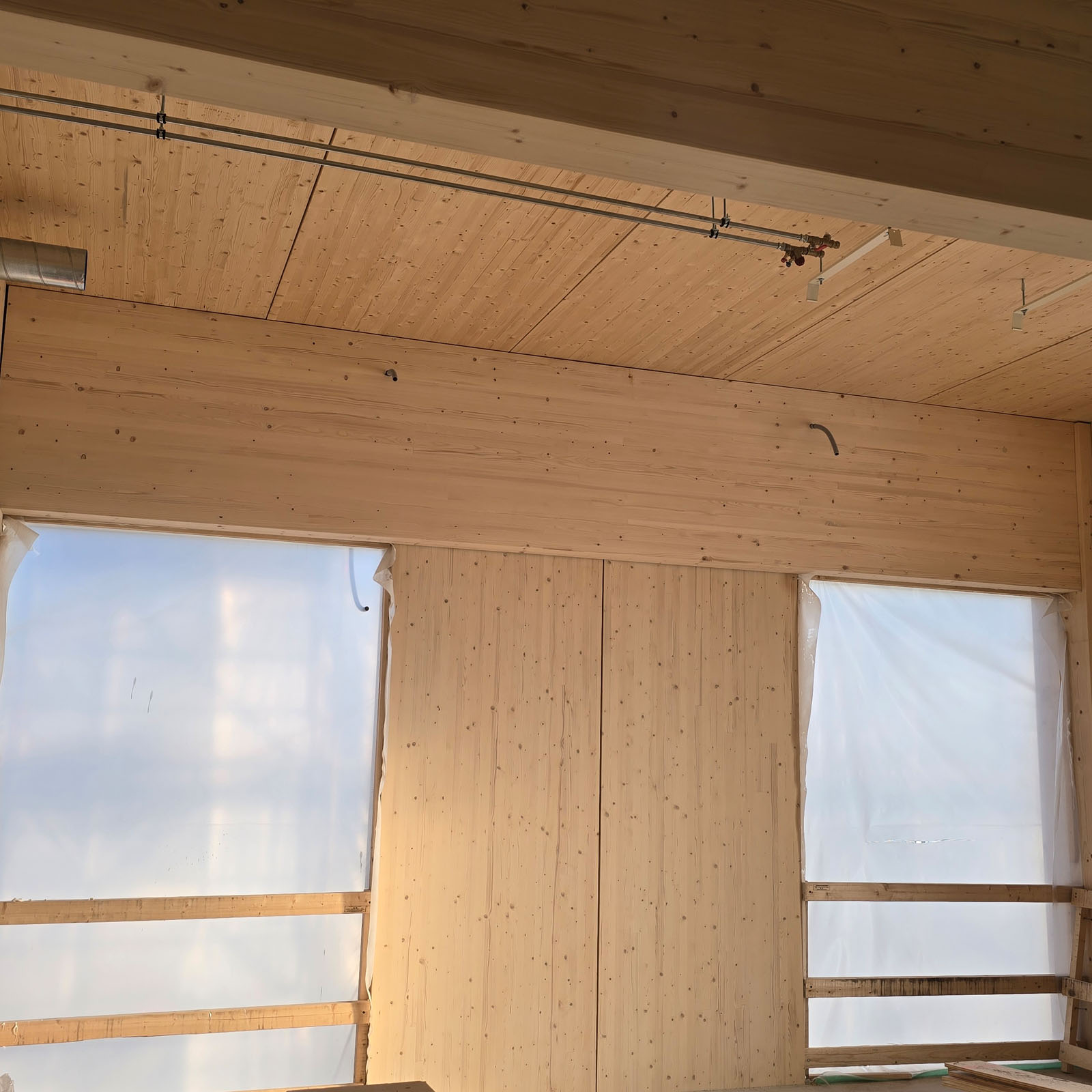

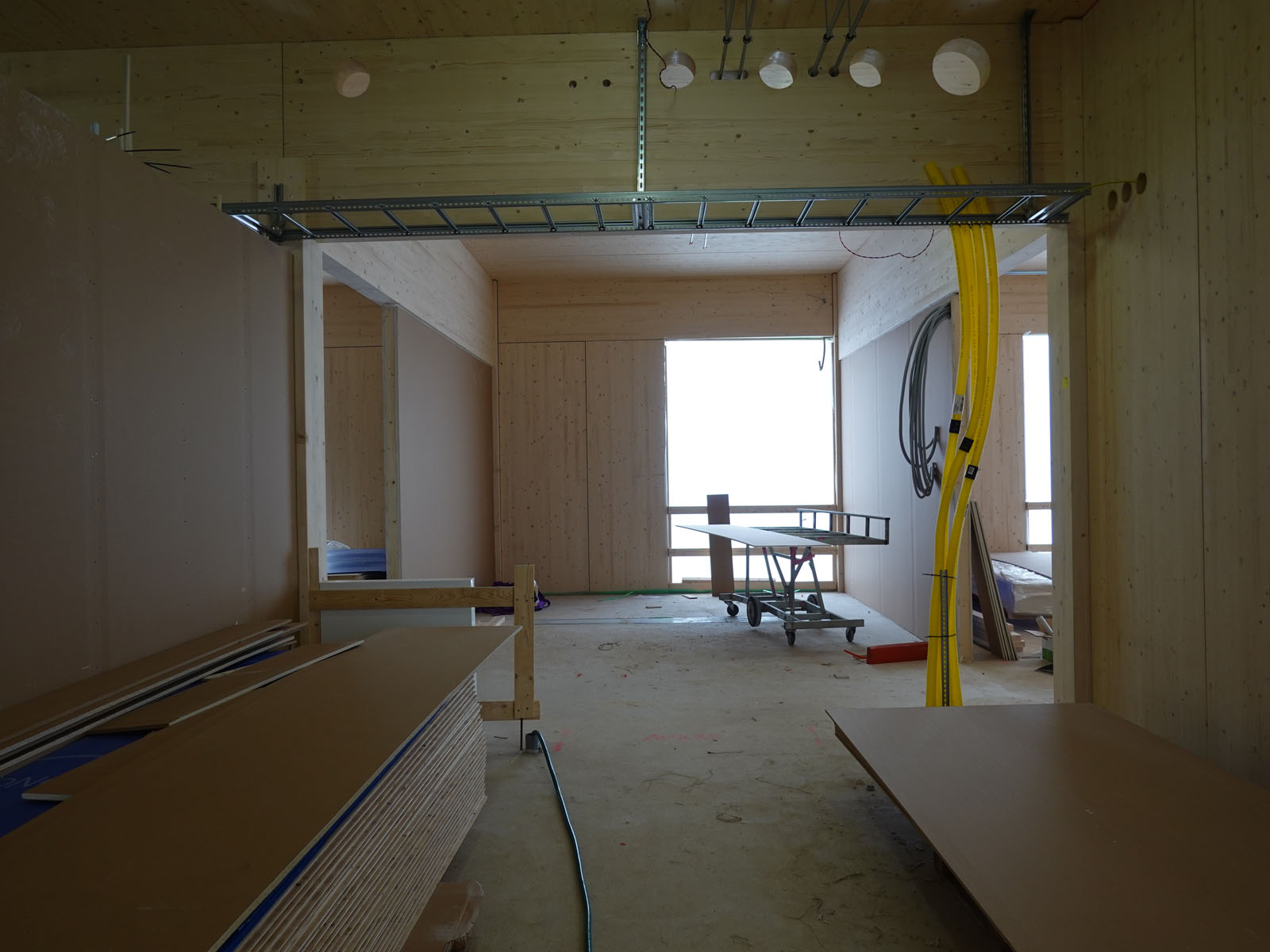

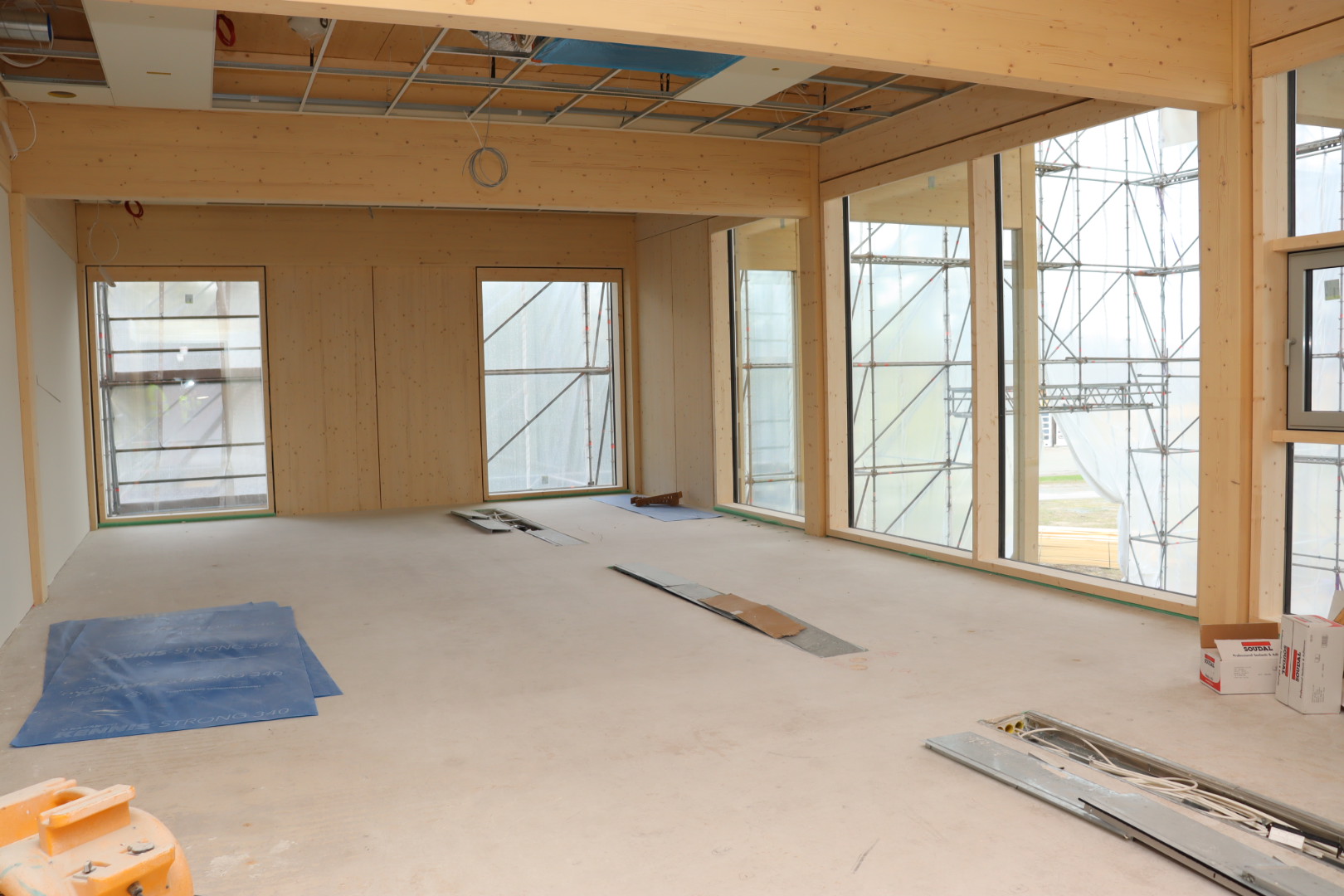

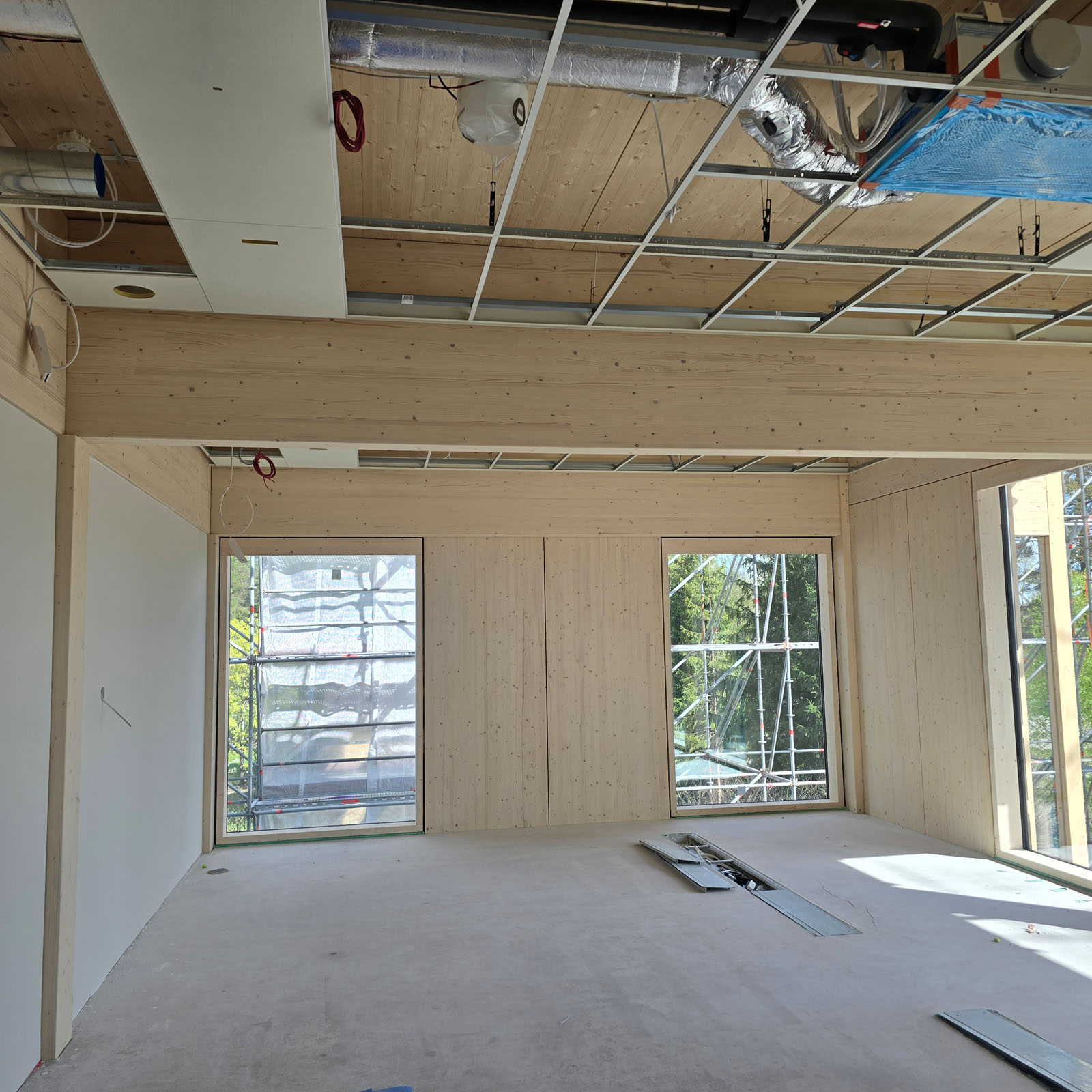

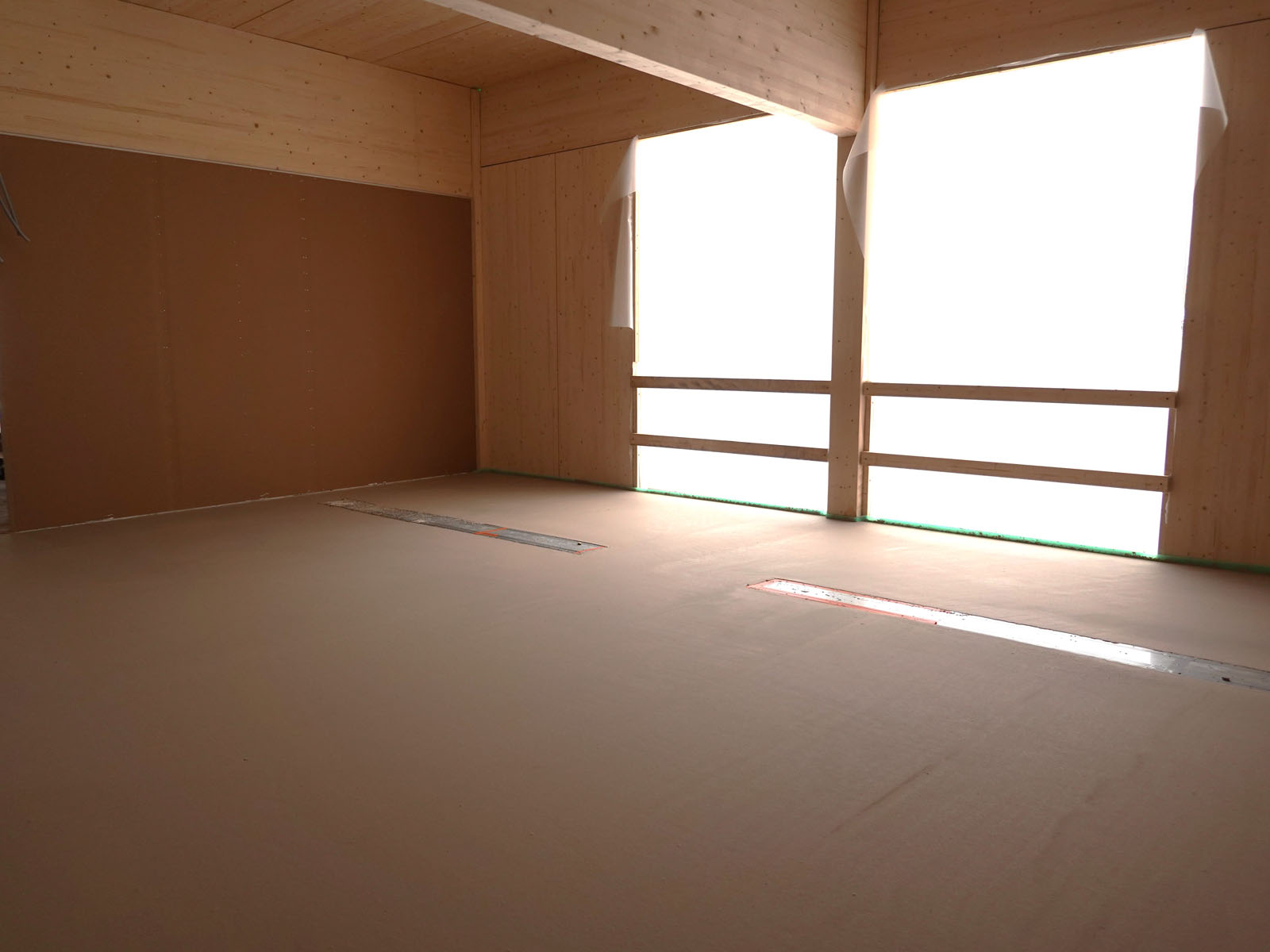

Completed and in progress in March: levelling and painting work, tiling work, installation of window panes, installation of interior frames, panelling of exterior walls, installation of wool and panels to the facade, partition wall masonry, lift installation.

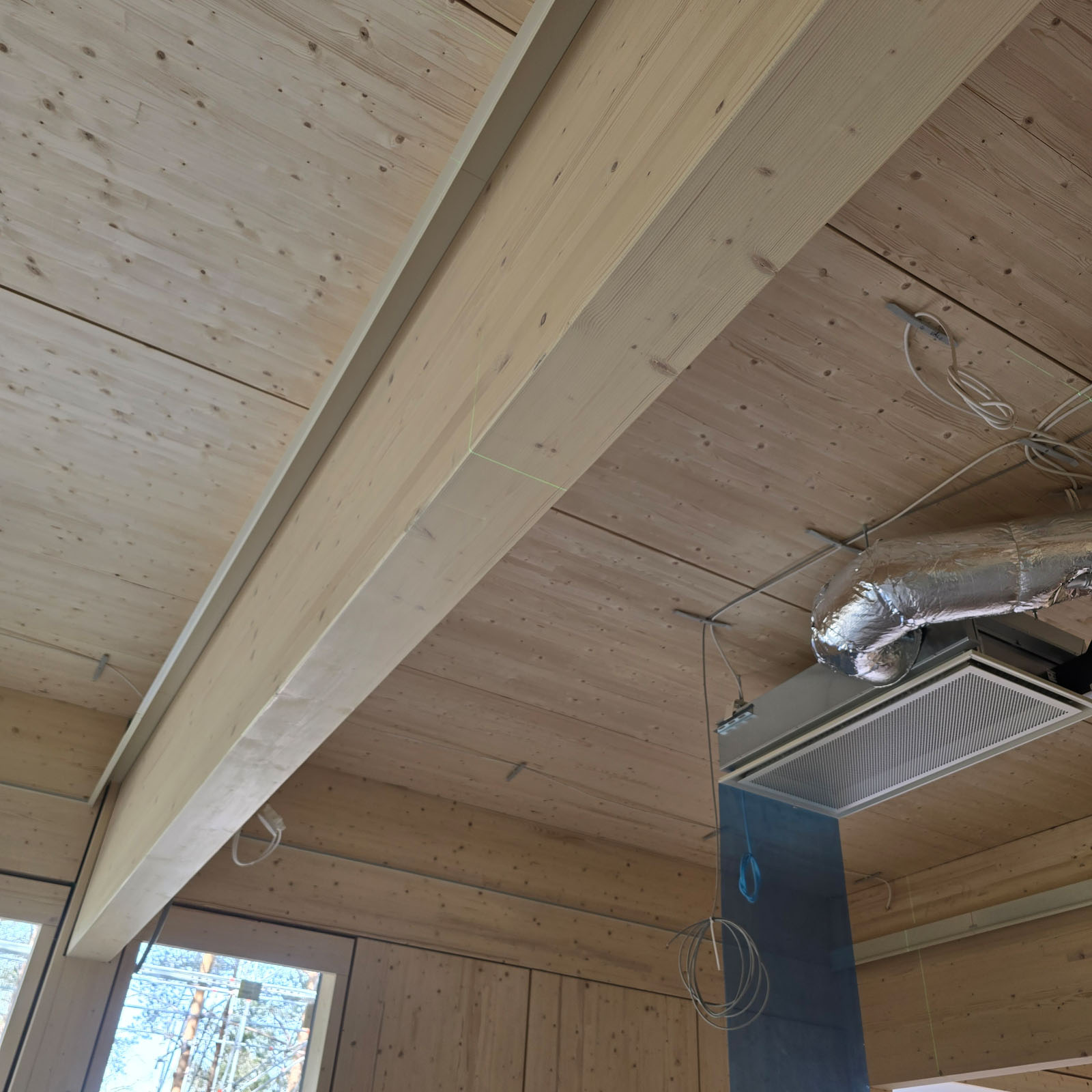

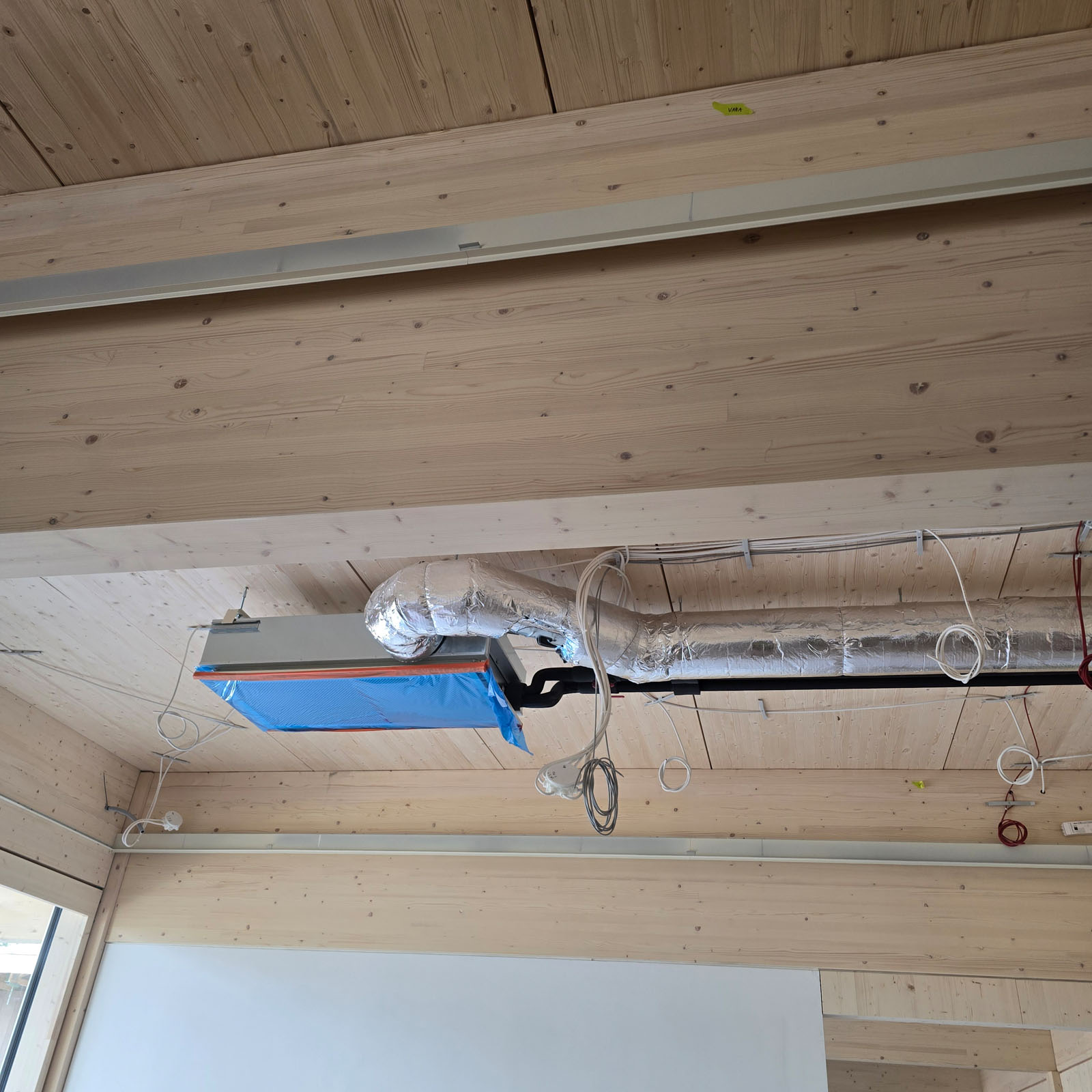

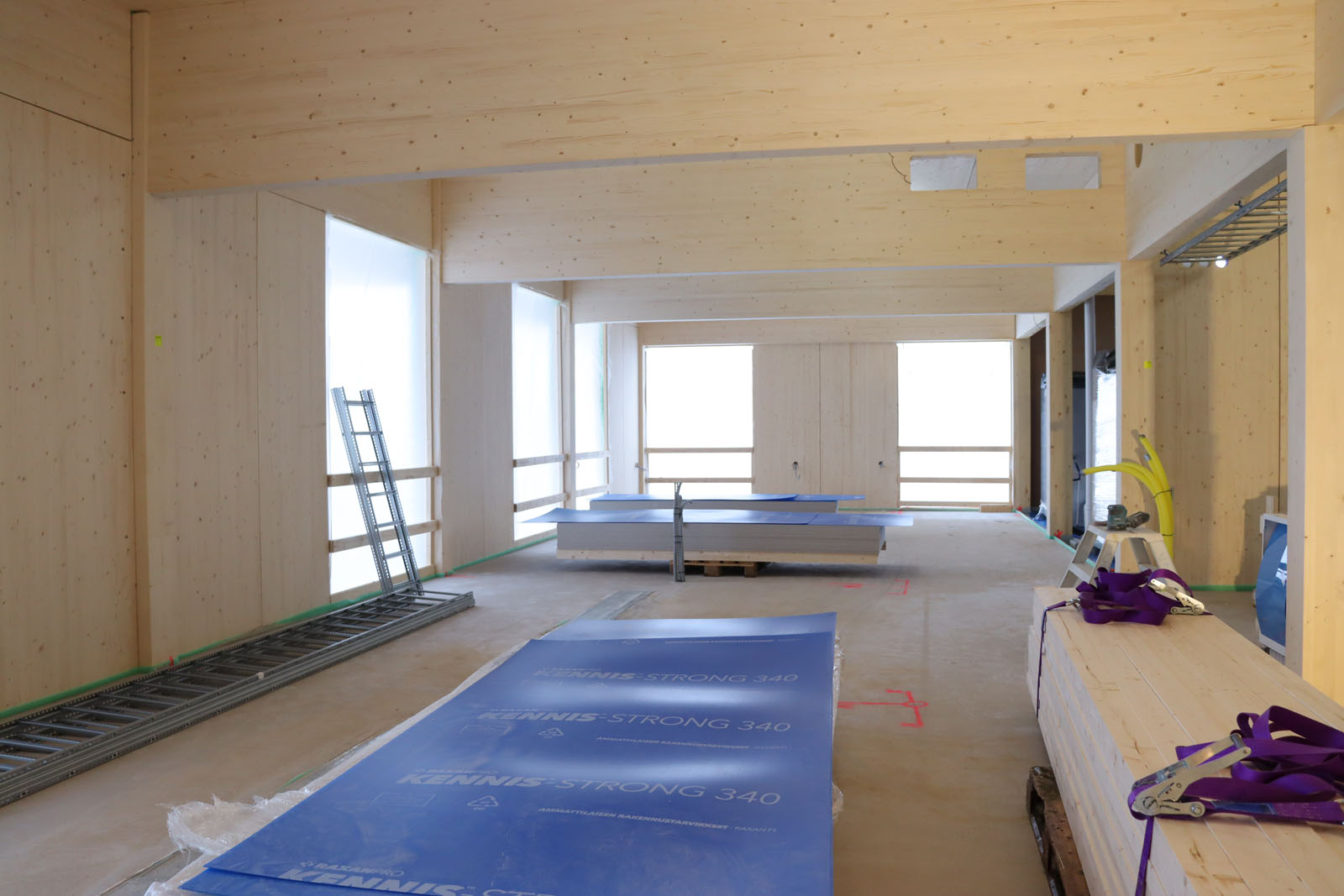

Completed and in progress in April: levelling and painting work continues, natural stone floor tiling work, installation of window panes, installation of interior frames, HVAC work and insulation, suspended ceiling work, firestops and caulking of interiors.

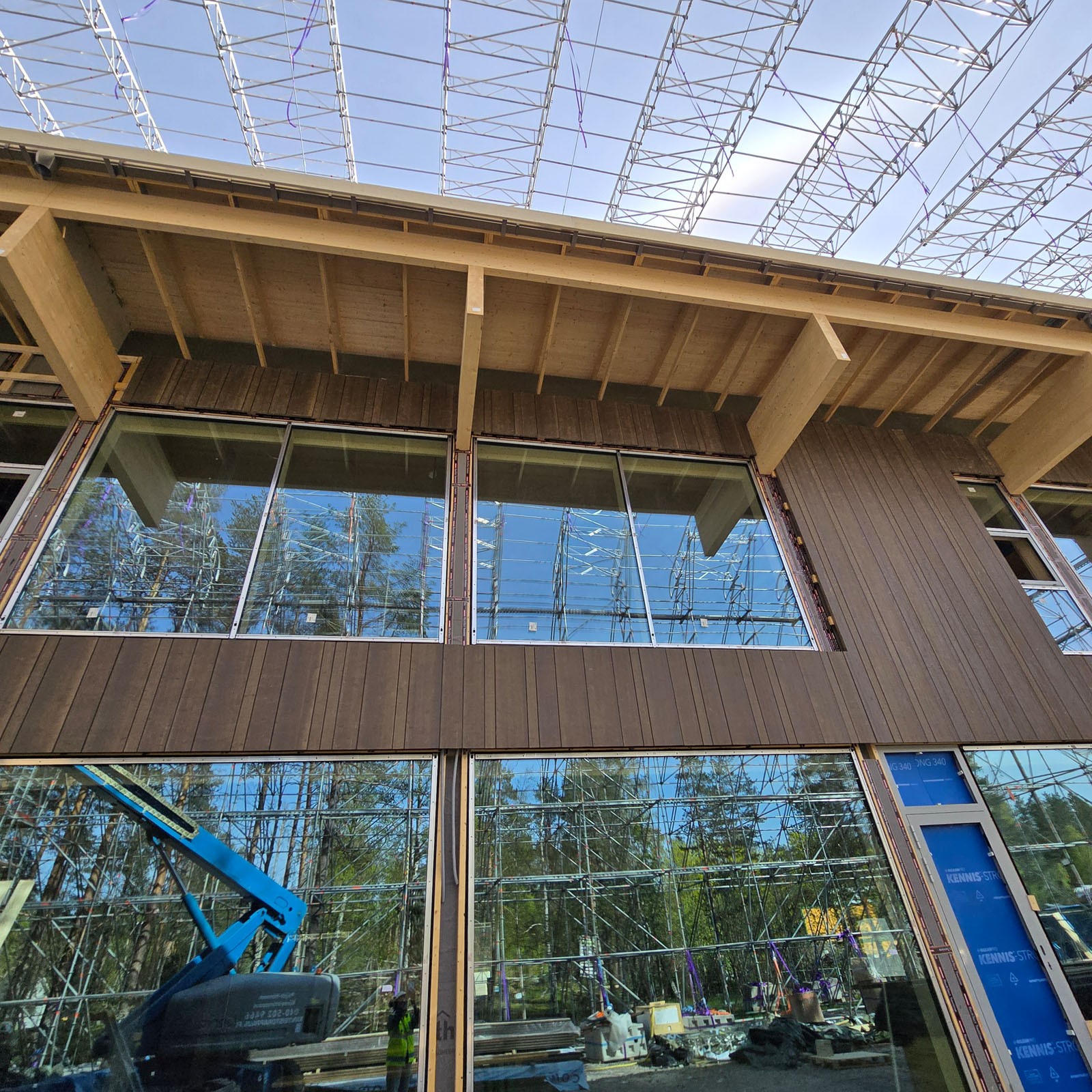

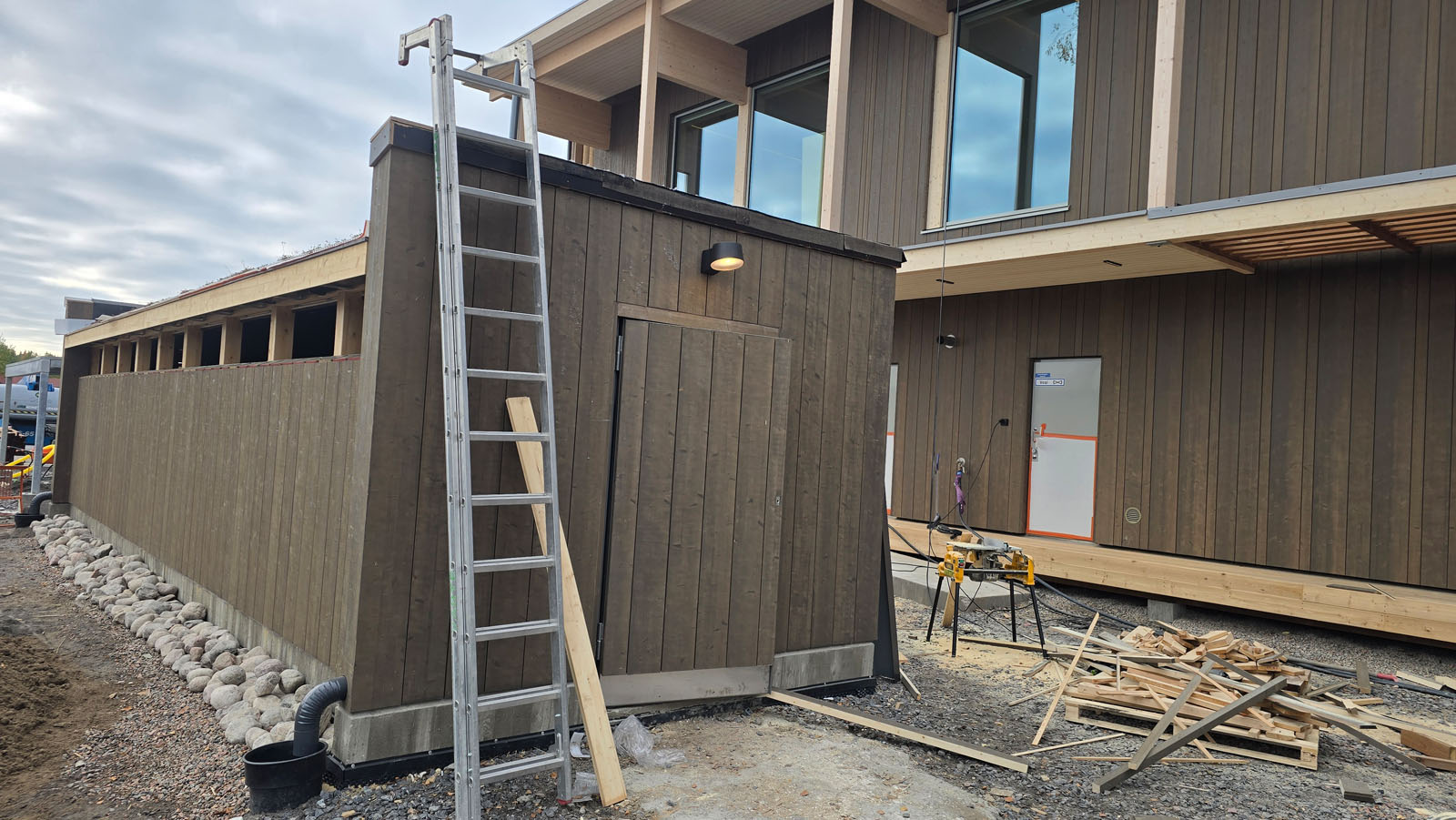

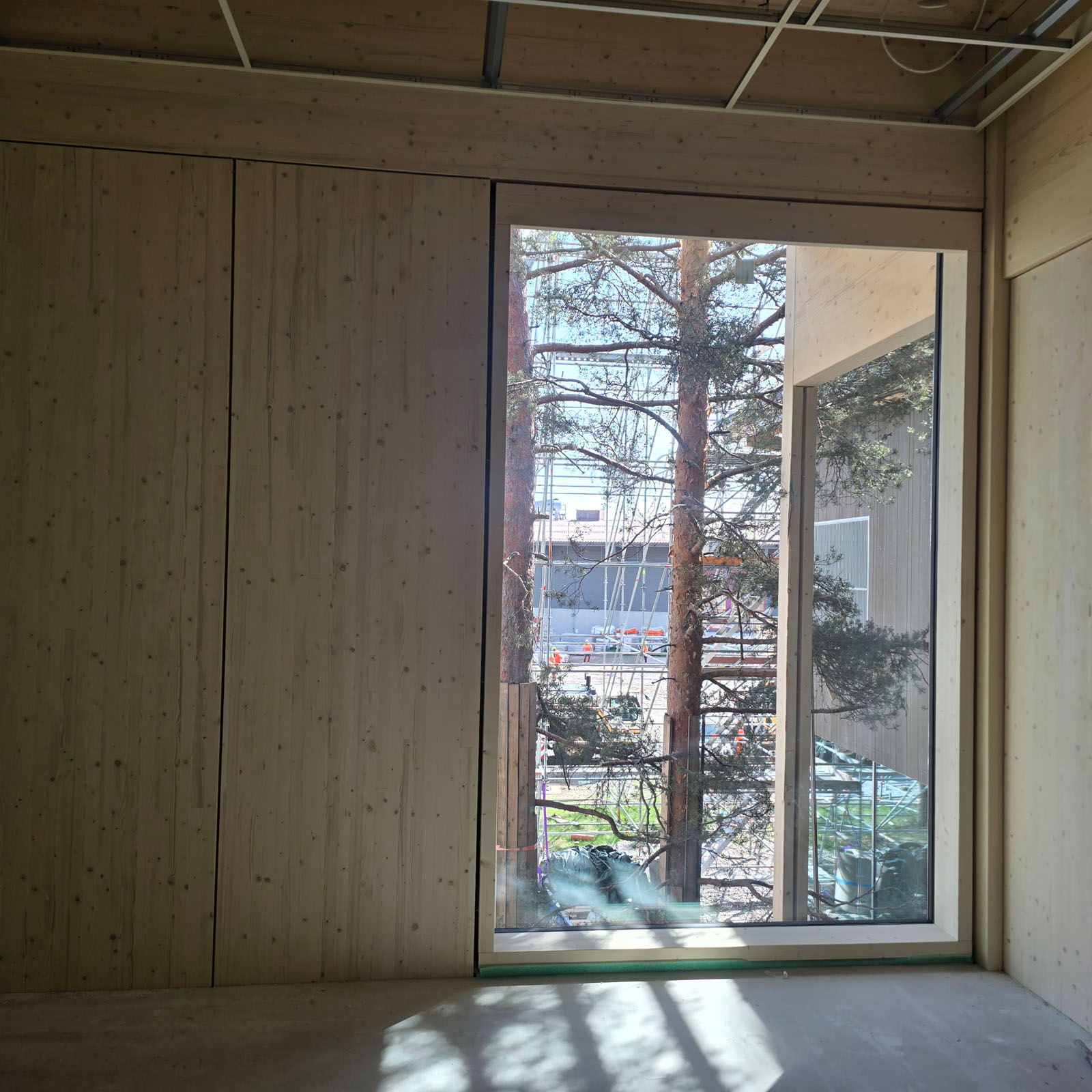

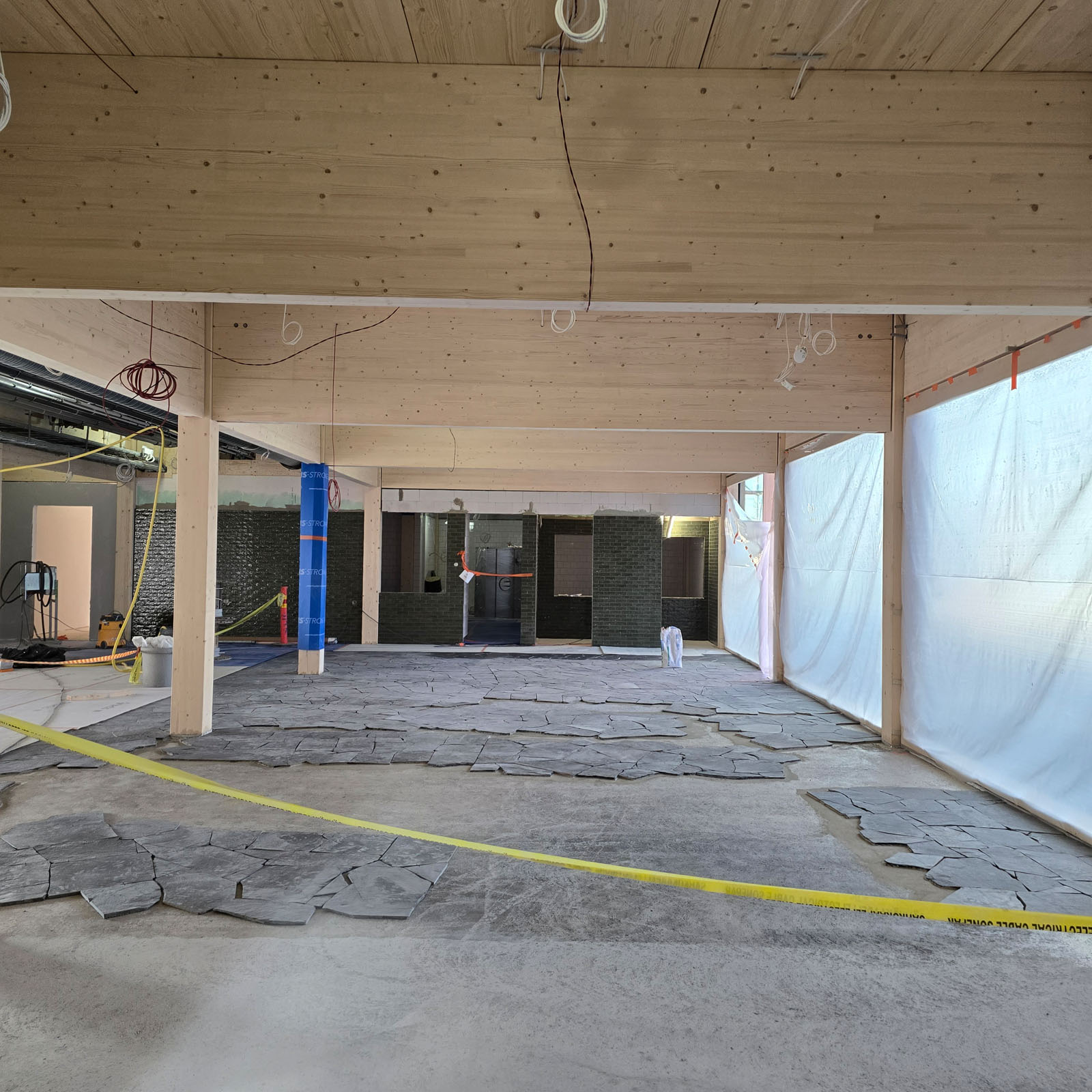

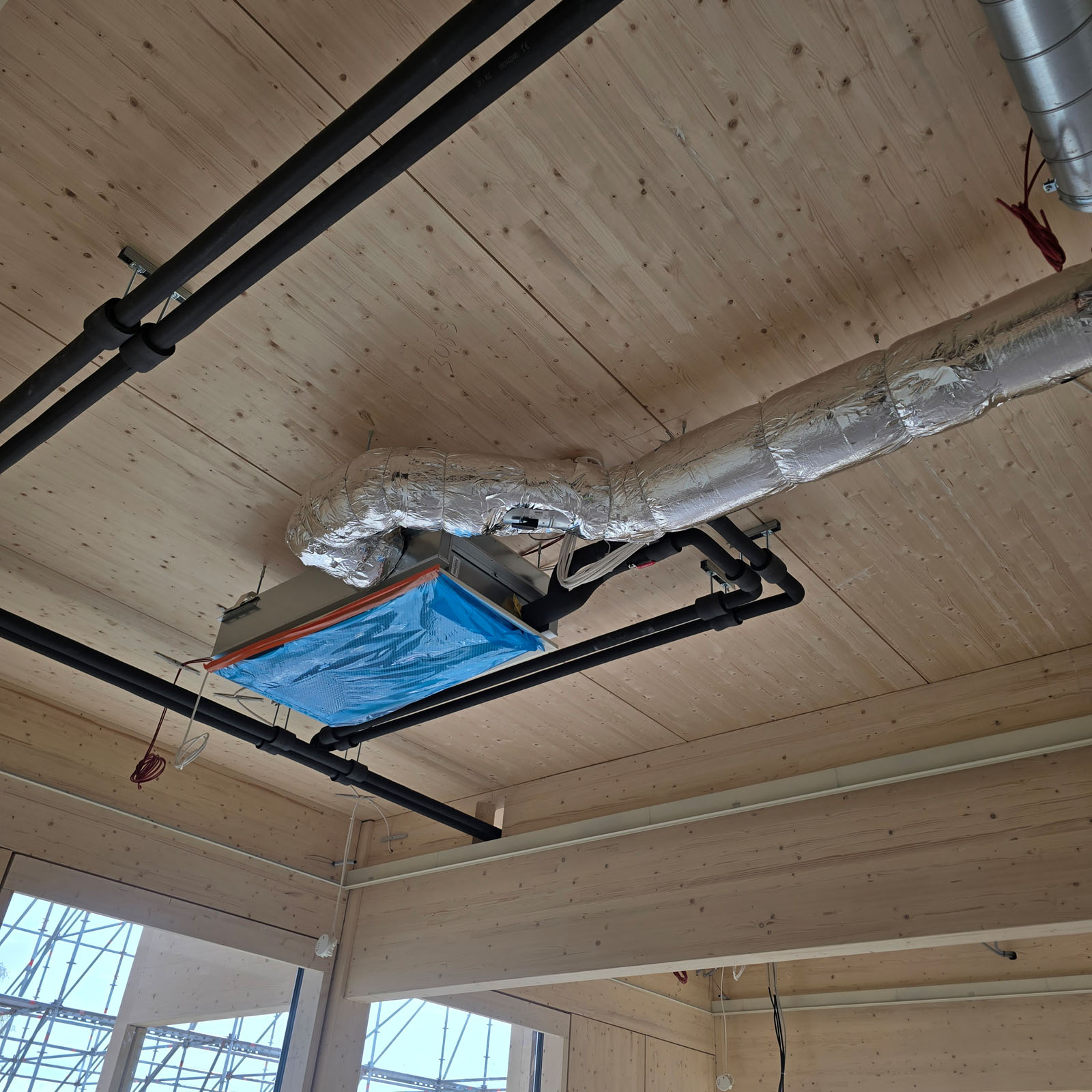

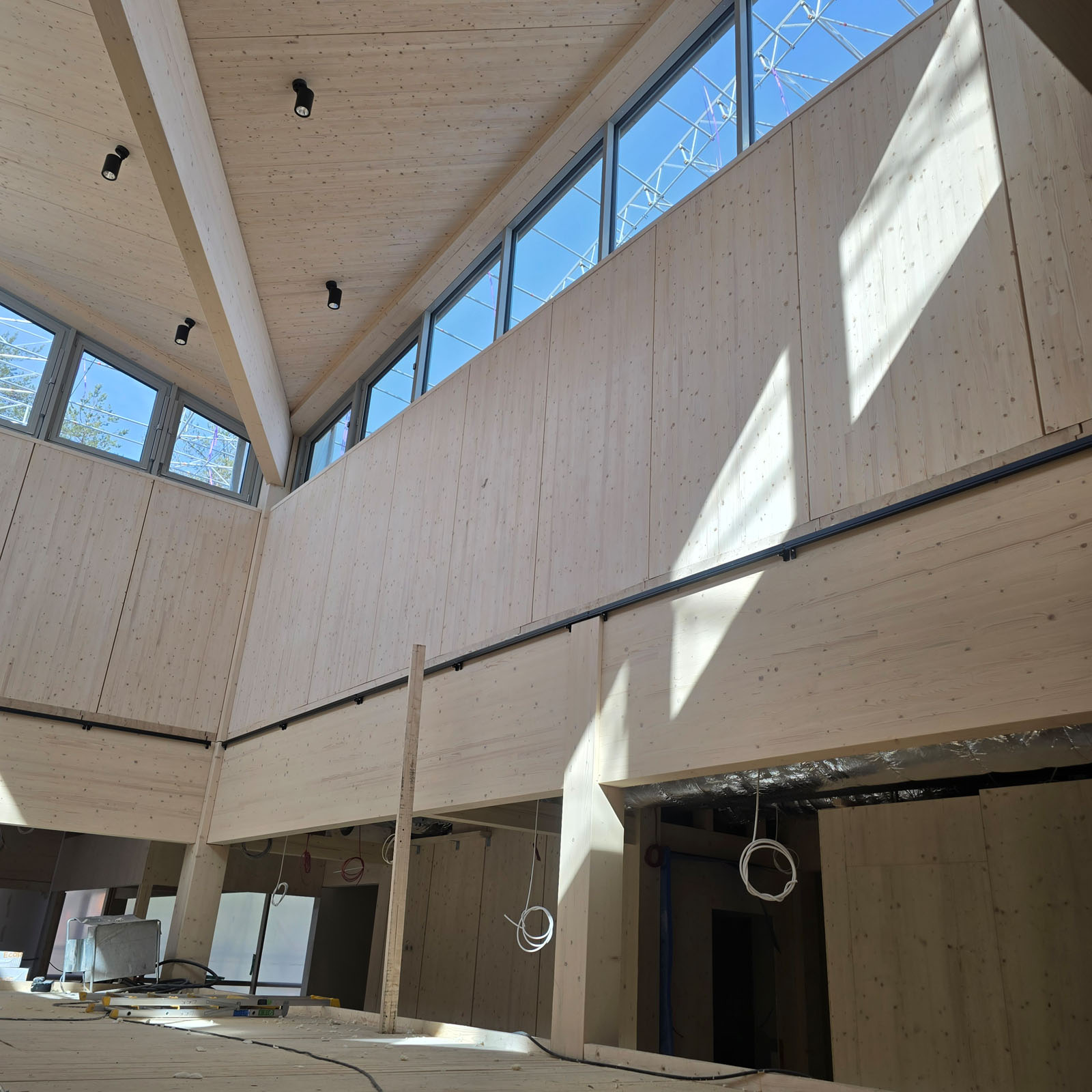

Completed and in progress in May: Window installation, suspended ceiling work, installation of interior frames, levelling and painting work, caulking, firestop work, panelling of exterior walls, work on coated floors, tiling work, disassembly of the weather protection.

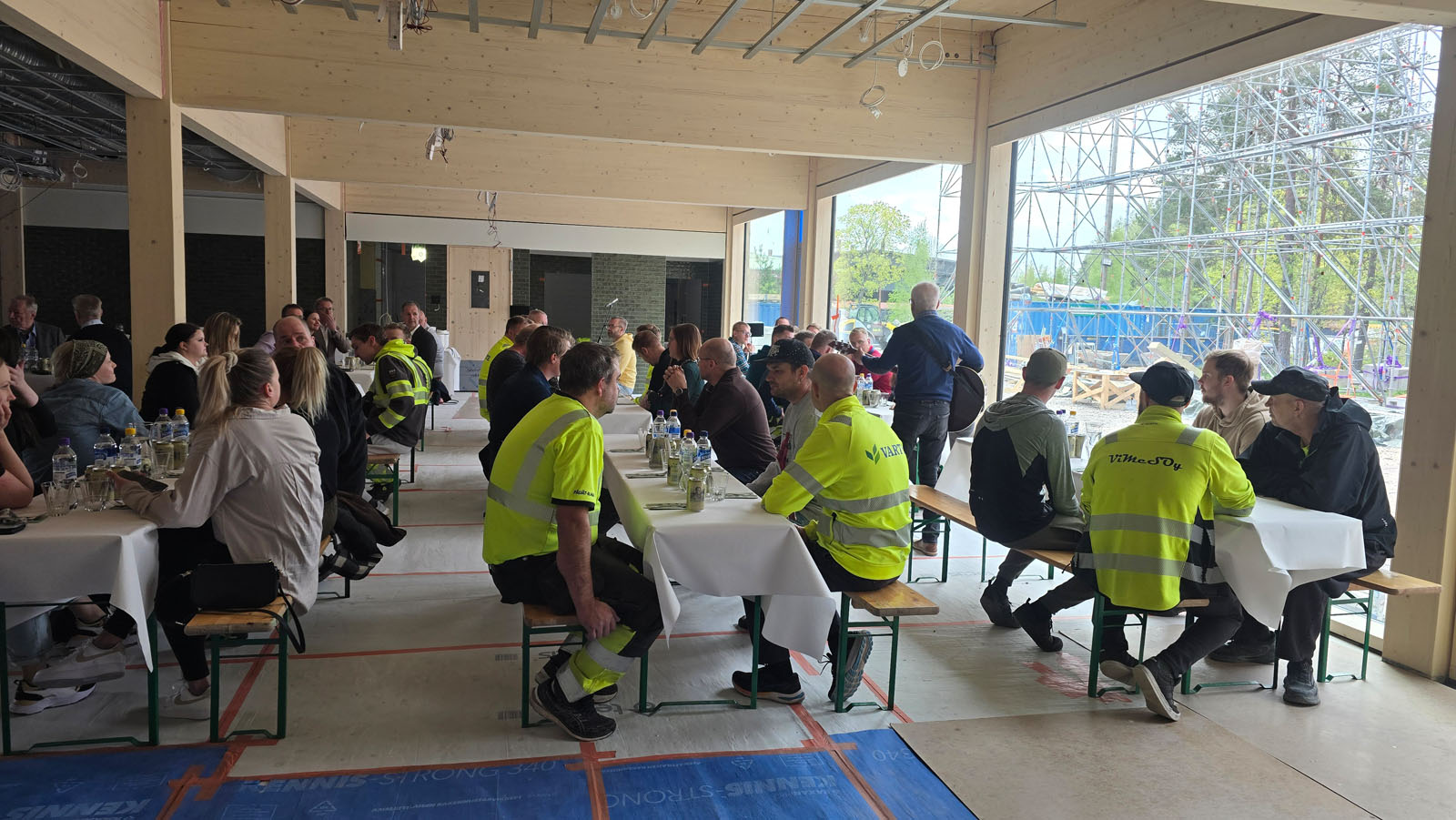

Today, we celebrated our new head office with a topping-out ceremony, where we thanked all our employees and partners involved in the construction for their contribution.

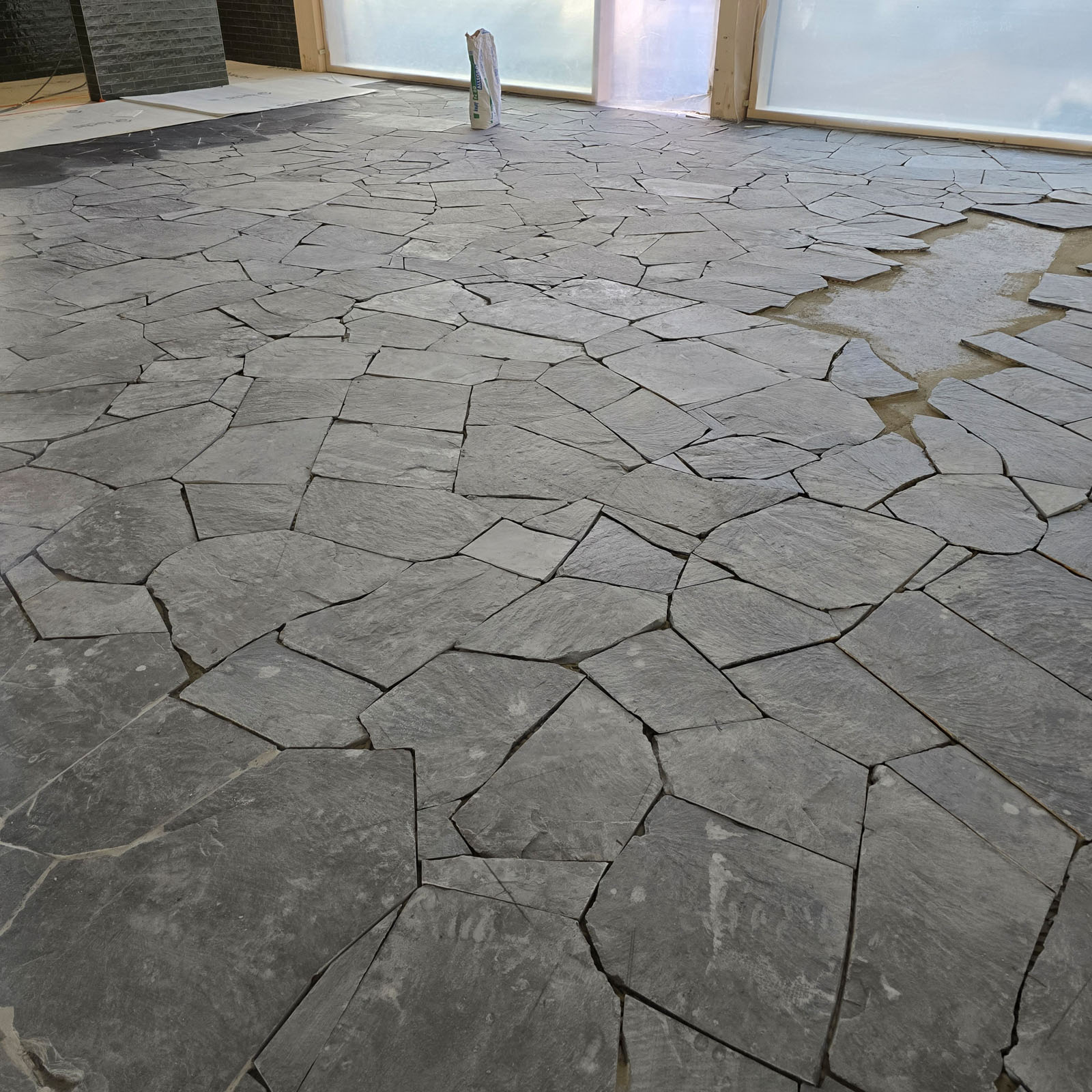

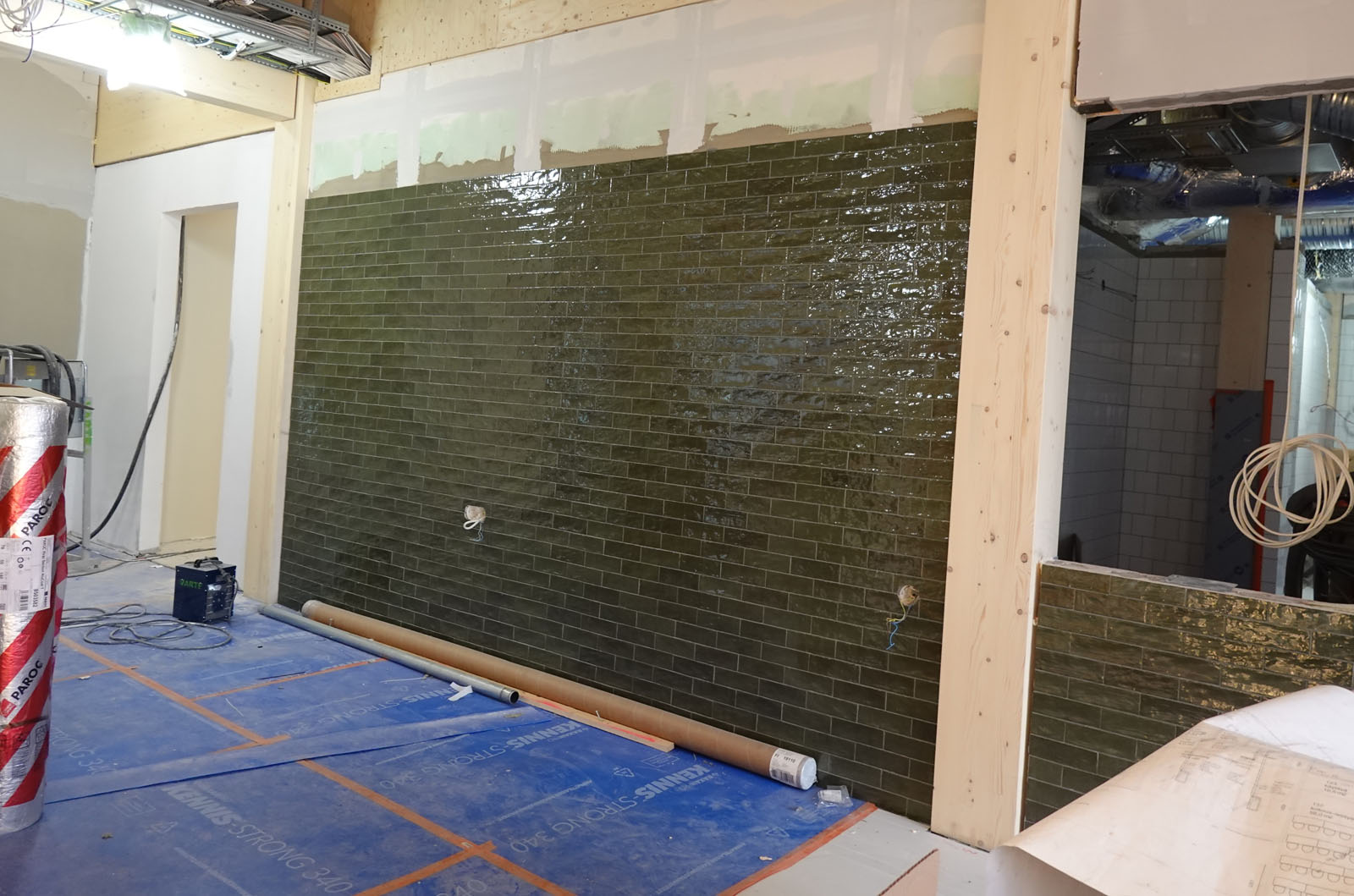

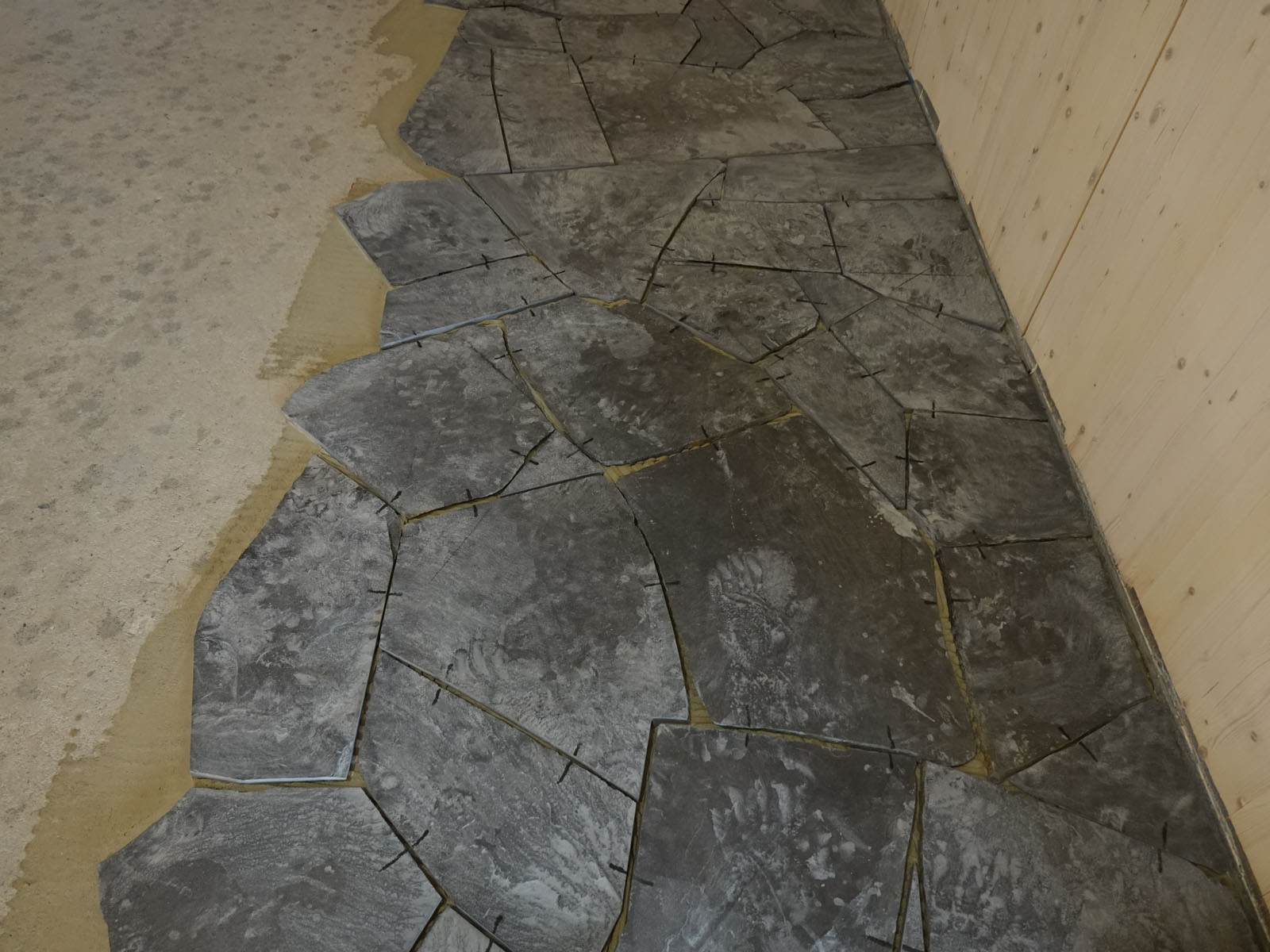

Tiling of the natural stone floors
The forest experience is visual, olfactory and tactile both outside and inside. Tomorrow grows from the forest.

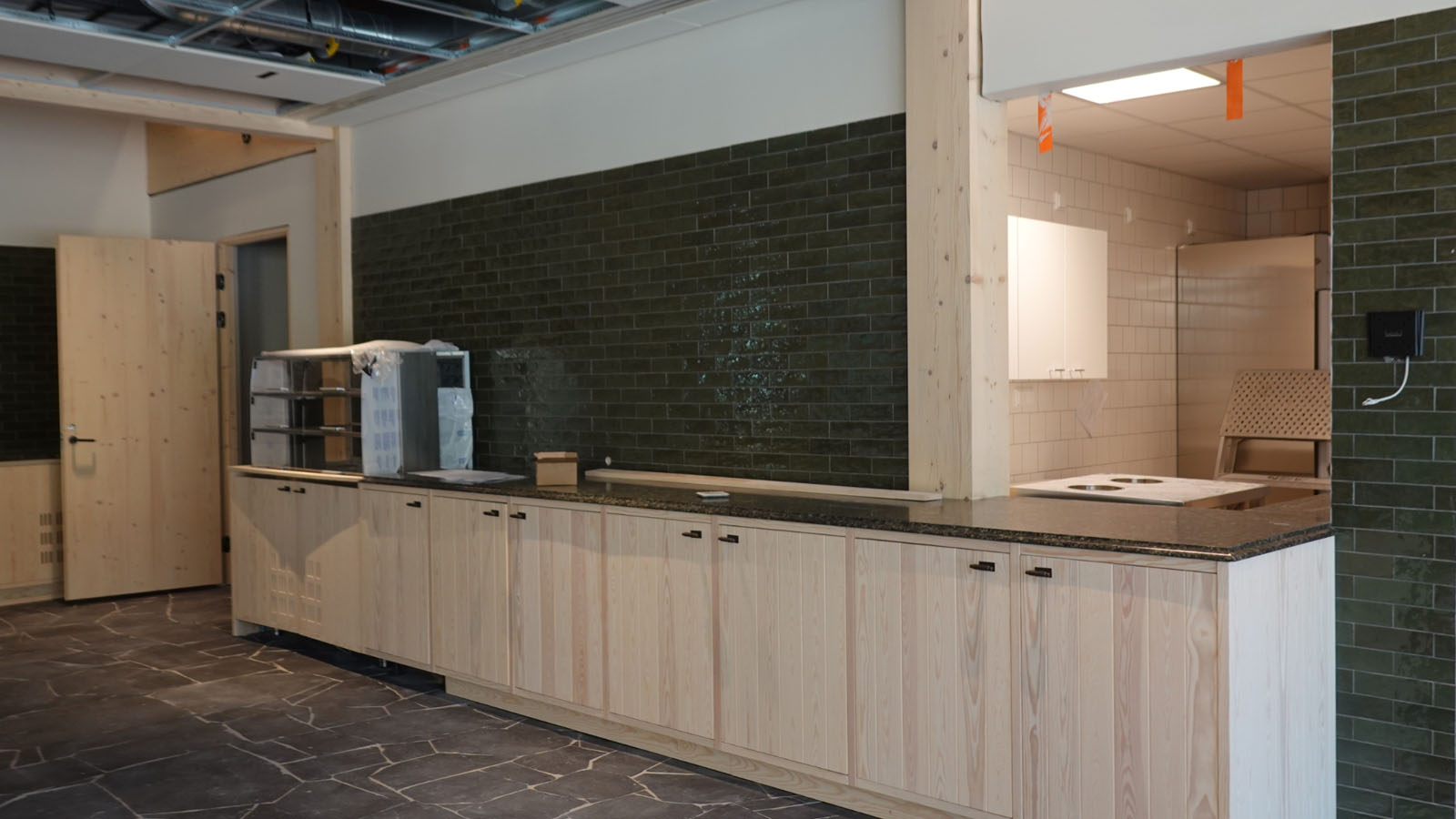

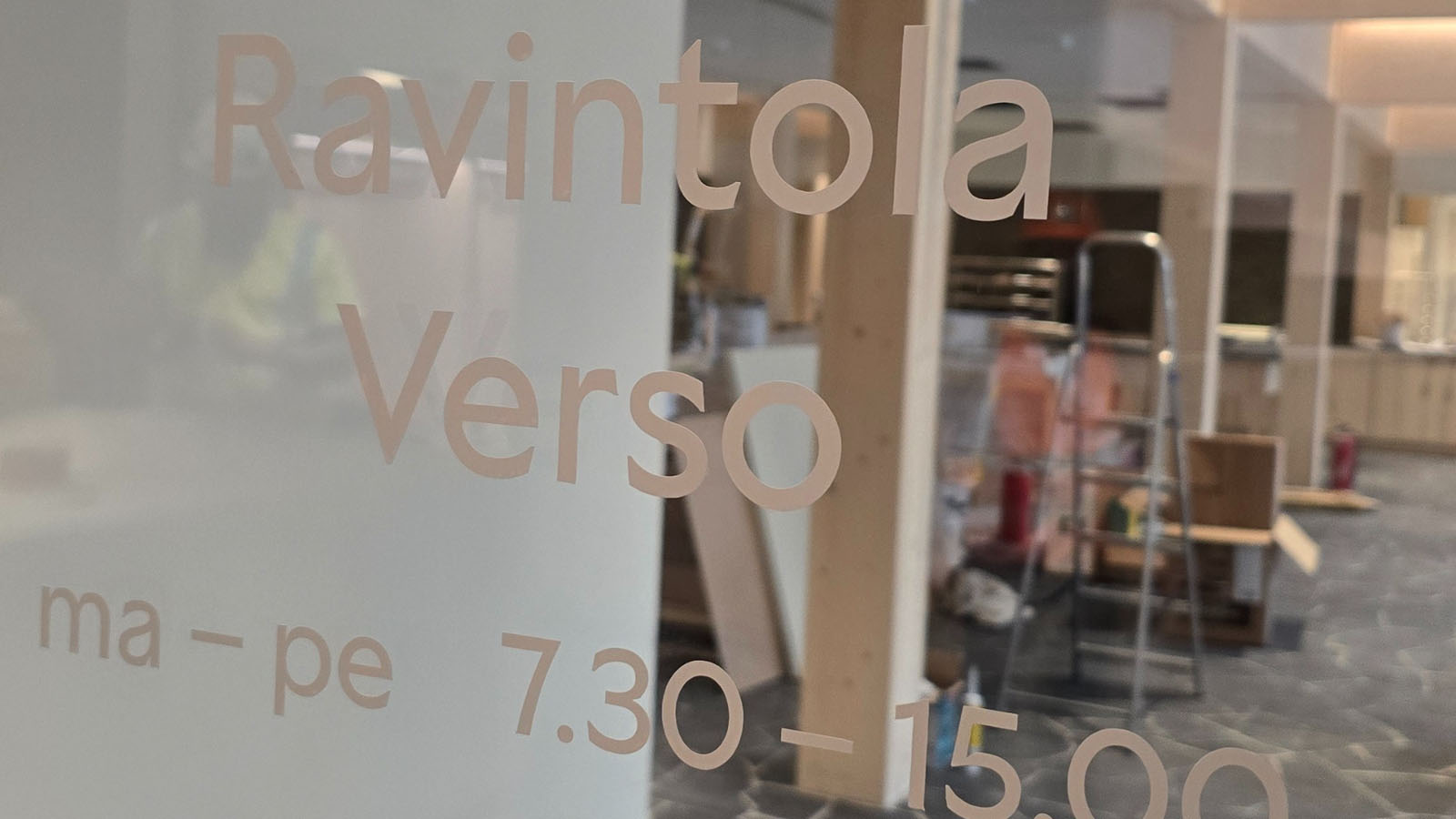

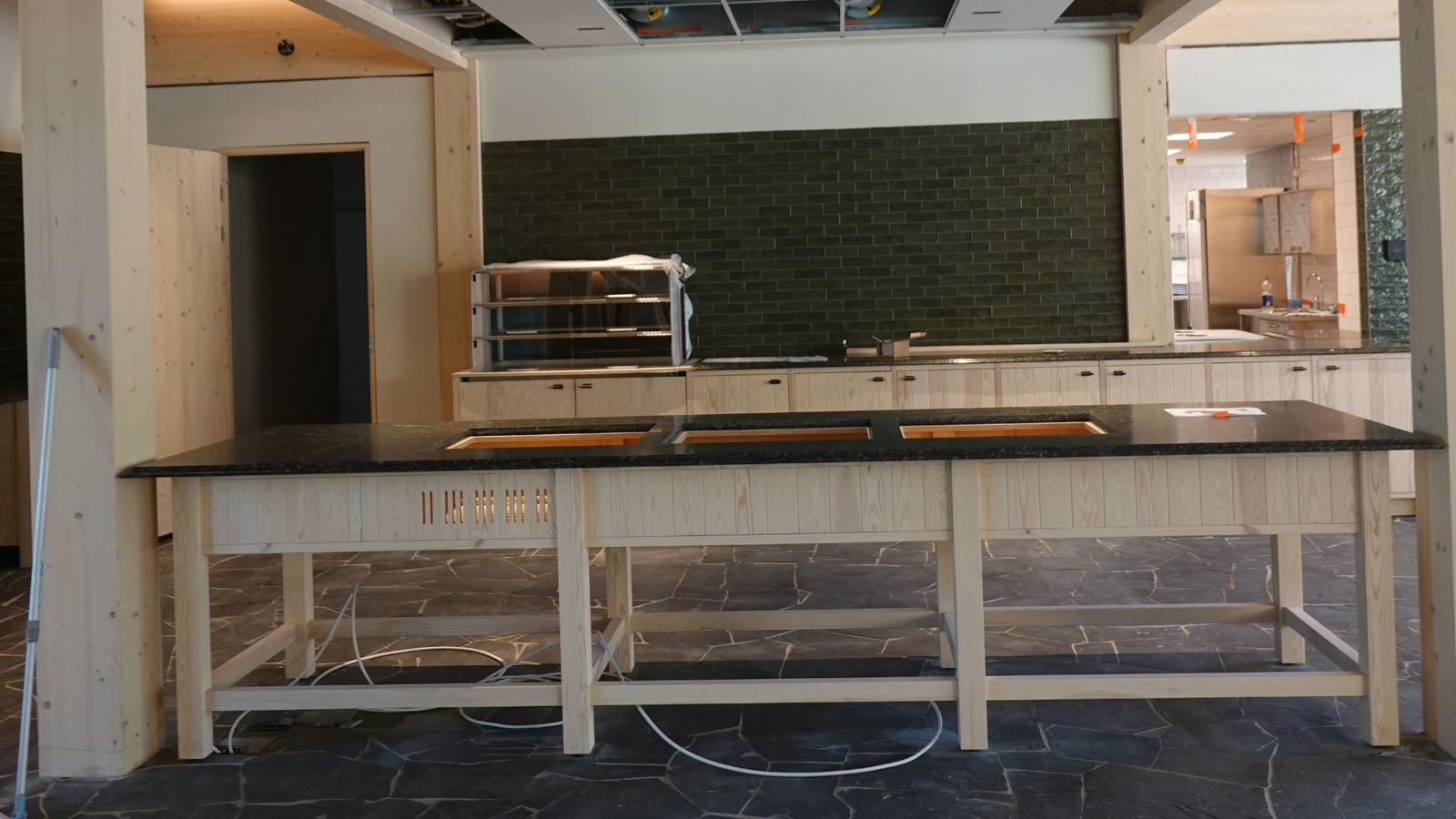

Completed: carpeting and tiling. In progress: painting, suspended ceiling work, earthworks, yard work, mouldings.

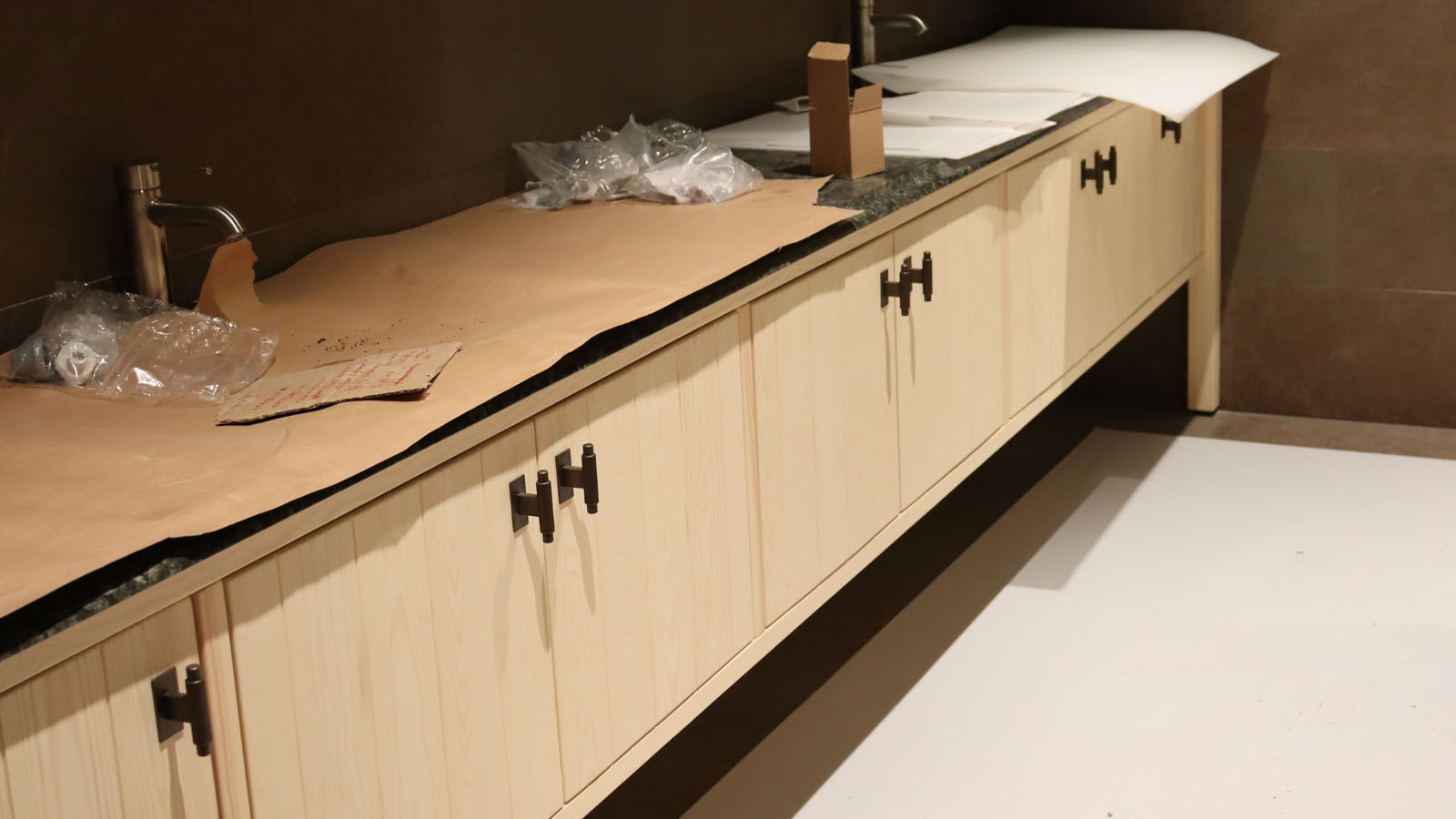

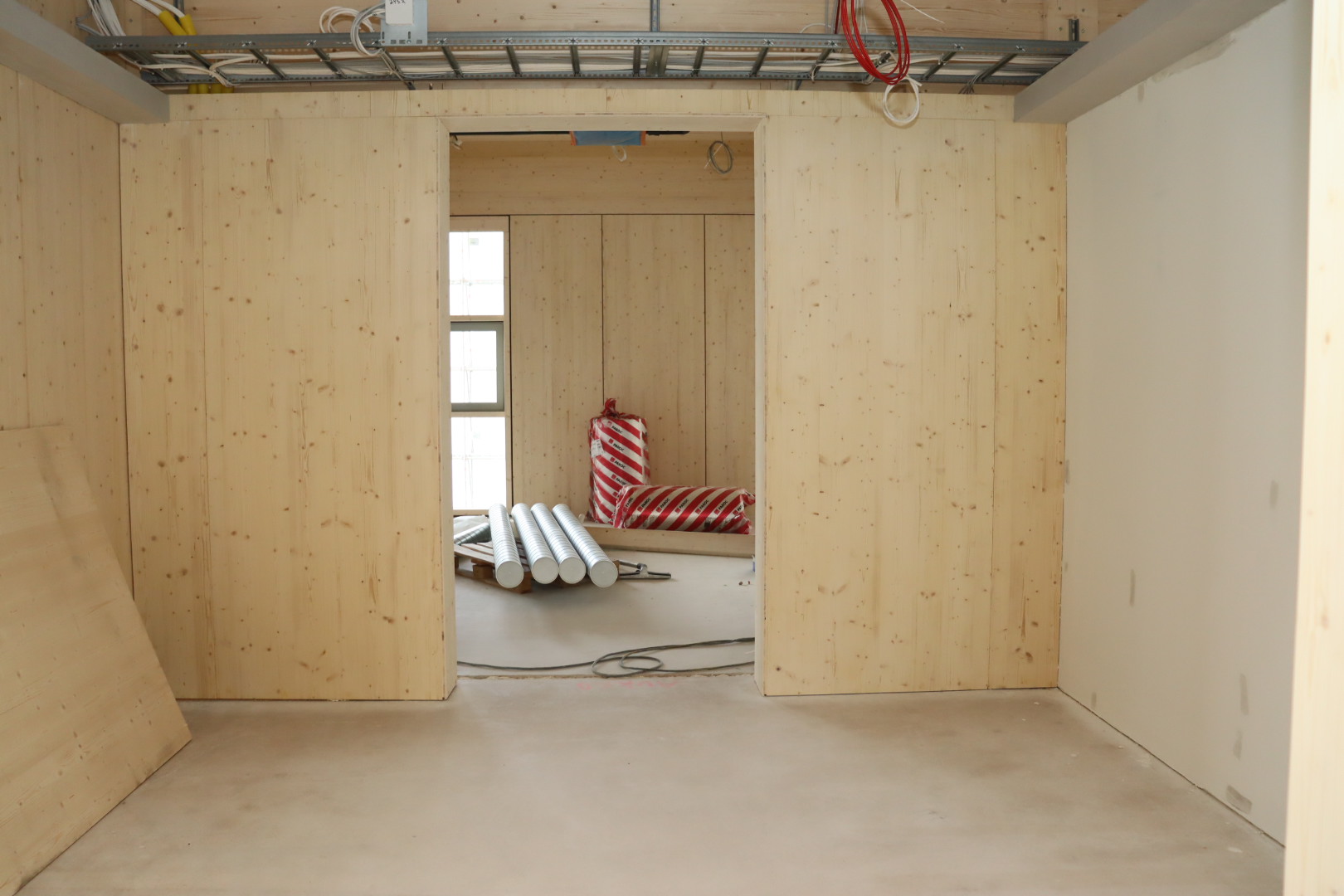

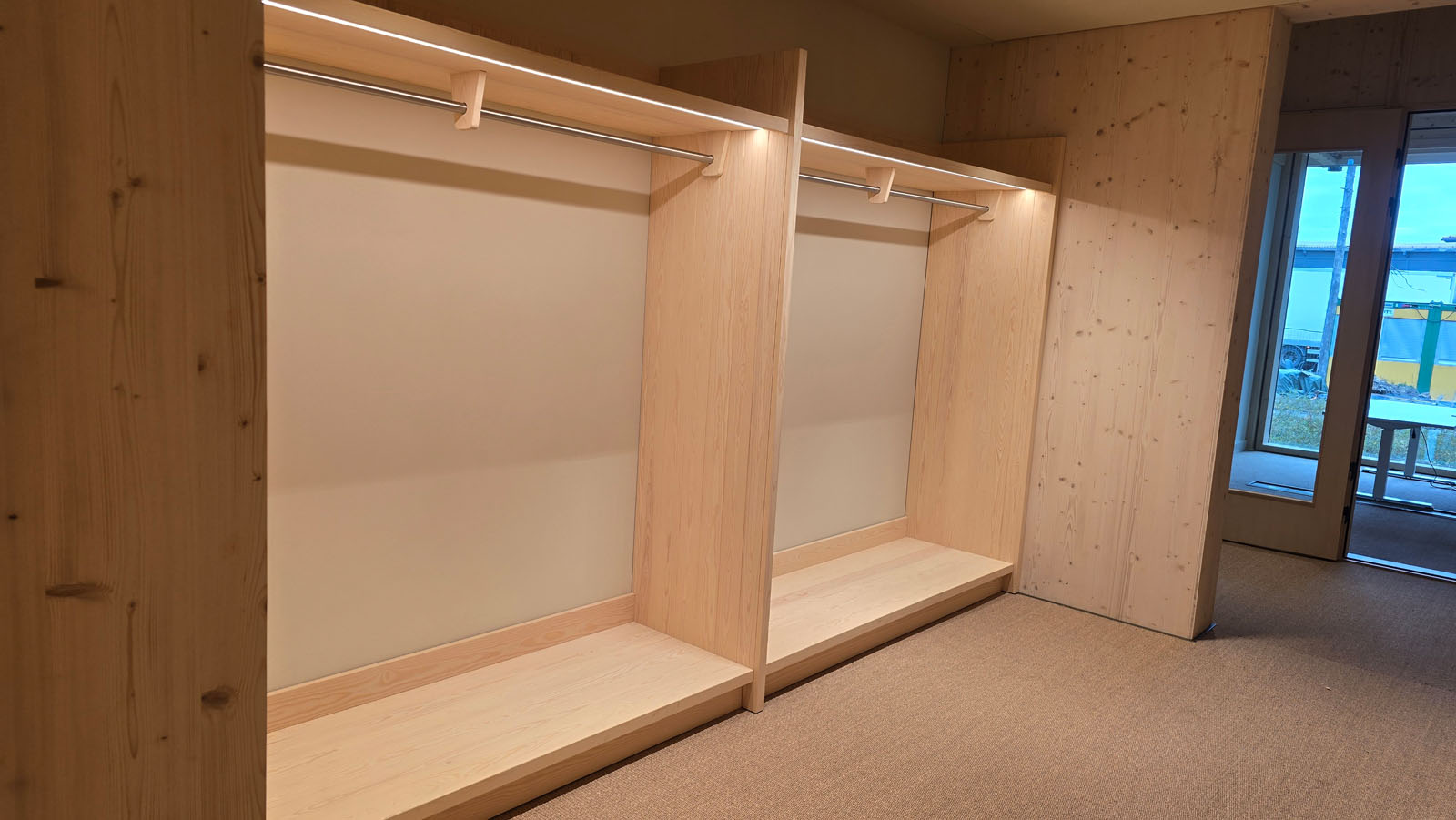

Earthworks completed. In progress: waste container shelter frame, installation of fixed furniture and IT equipment.

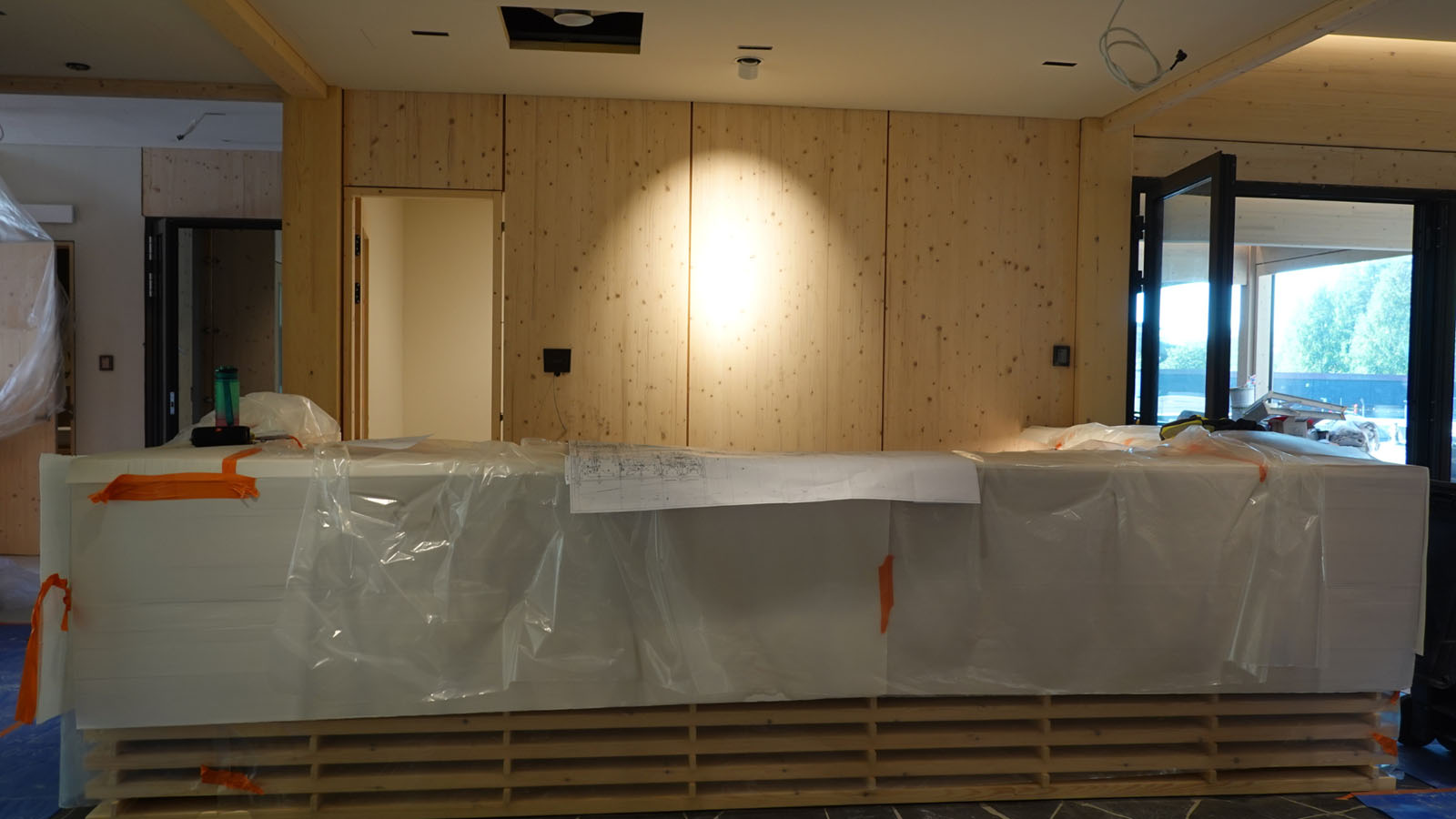

In progress: construction of the terrace, yard work, mounting of indoor signage, installation of fixed furniture continues.
Video presenting Versowood’s new head office for the Open House day on 26 September 2025.
